CITY OF PUYALLUP PERMITTING PORTAL
Permit Application Status
B-20-0078
In order to request inspections, you need to be signed in.
Paid Fees | Amount | Paid | Owing | Date Paid |
---|---|---|---|---|
Building Plan Review Fee | $5,555.55 | $5,555.55 | Paid | 02/11/2020 |
No
|
||||
Fire Review Fee (Commercial Building) | $265.00 | $265.00 | Paid | 04/01/2022 |
Ventilation System (apart from Heating/AC) Fee | $423.00 | $423.00 | Paid | 04/01/2022 |
Air Handling Unit (Up to 10,000 cfm) Fee | $14.10 | $14.10 | Paid | 04/01/2022 |
Furnace (up to 100,000 BTU) Fee | $586.50 | $586.50 | Paid | 04/01/2022 |
Building Permit Fee | $13,587.65 | $13,587.65 | Paid | 04/01/2022 |
Mechanical Permit Fee | $40.00 | $40.00 | Paid | 04/01/2022 |
Water Heater Fee | $13.00 | $13.00 | Paid | 04/01/2022 |
Plumbing Permit Fee | $40.00 | $40.00 | Paid | 04/01/2022 |
Plumbing Fixtures Fee | $390.00 | $390.00 | Paid | 04/01/2022 |
Mechanical Plan Review Fee | $695.44 | $695.44 | Paid | 04/01/2022 |
Plumbing Plan Review Fee | $287.95 | $287.95 | Paid | 04/01/2022 |
WA State Building Code Council Fee (Commercial) | $25.00 | $25.00 | Paid | 04/01/2022 |
Gas Piping (Mechanical) Fee | $6.30 | $6.30 | Paid | 04/01/2022 |
$0.00
|
||||
Planning Landscape Review Fee | $300.00 | $300.00 | Paid | 04/01/2022 |
Planning Building Permit Fee | $120.00 | $120.00 | Paid | 04/01/2022 |
Traffic Impact Fee (Commercial) | $65,700.00 | $65,700.00 | Paid | 04/01/2022 |
$0.00
|
||||
Sewer System Development Charge | $111,321.00 | $111,321.00 | Paid | 04/01/2022 |
Water System Development Charge | $80,514.00 | $80,514.00 | Paid | 04/01/2022 |
Building Division Fee (Hourly) | $130.00 | $130.00 | Paid | 04/01/2022 |
Resubmittal Fee | $130.00 | $130.00 | Paid | 04/21/2022 |
Resubmittal Fee | $130.00 | $130.00 | Paid | 08/02/2022 |
Building Division Fee (Hourly) | $260.00 | $260.00 | Paid | 11/10/2022 |
Engineering Additional Review Fee | $130.00 | $130.00 | Paid | 11/10/2022 |
Resubmittal Fee | $180.00 | $180.00 | Paid | 10/26/2023 |
Resubmittal Fee | $180.00 | $180.00 | Paid | 12/27/2023 |
Resubmittal Fee | $180.00 | $180.00 | Paid | 03/05/2024 |
Resubmittal Fee | $180.00 | $180.00 | Paid | 03/25/2024 |
Building Permit Fee | $6,793.82 | $6,793.82 | Paid | 05/07/2024 |
$13,587.65
|
||||
Building Division Fee (Hourly) | $540.00 | $540.00 | Paid | 06/07/2024 |
Inspection Fee - Outside Of Business Hours | $540.00 | $540.00 | Paid | 06/14/2024 |
Inspection Fee - Outside Of Business Hours | $540.00 | $540.00 | Paid | 06/21/2024 |
Inspection Fee - Outside Of Business Hours | $540.00 | $540.00 | Paid | 07/05/2024 |
Building Re-Inspection Fee | $180.00 | $180.00 | Paid | 09/18/2024 |
Inspection Fee - Outside Of Business Hours | $540.00 | $540.00 | Paid | 10/11/2024 |
Outstanding Fees | Amount | Paid | Owing | Date Paid |
No outstanding fees. | ||||
Totals: | $291,058.31 | $291,058.31 | $0.00 |
Permit(s) will not be issued until outstanding fees have been paid in full. Fee details shown above only include currently payable fees, there might be addtional fees to be paid before issuance.
$0.00
Inspection | Outcome | Requested | Scheduled | Date Inspected |
---|---|---|---|---|
Comment Building Div Inspection | Not Ready | 4/13/2022 | 4/13/2022 | 04/13/2022 |
Shannon King ((253) 840-6684) | ||||
Planning Final Inspection | VOID | 10/25/2022 | ||
Chris Beale ((253) 841-5418) | ||||
Erosion And Sediment Inspection | Not Ready | 4/26/2023 | 4/26/2023 | 04/26/2023 |
Michael Rosenau ((253) 344-6753) | ||||
Comment Building Div Inspection | Not Ready | 5/24/2023 | 5/24/2023 | 05/24/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/24/2023
1 ; provide full set of City approved plans on-site at time of inspection.
2 ; provide all geo-tech and special inspection reports at time of building inspection.
not ready
|
||||
Footing/Setback Inspection | Failed | 8/24/2023 | 8/24/2023 | 08/24/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
08/24/2023

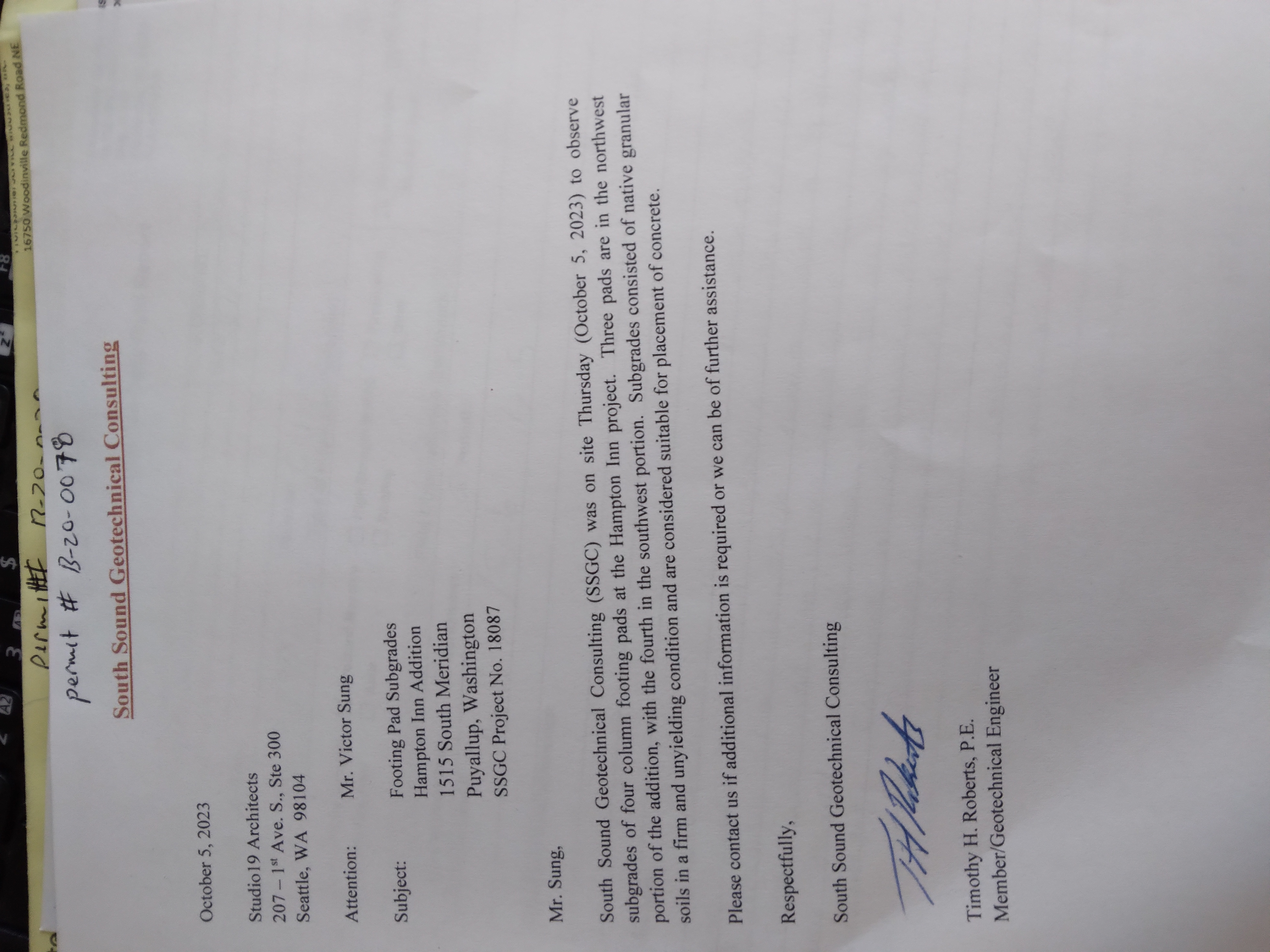

1 ; provide Geo-tech approval for soil bearing of 4,000 psf as required per structural sheets of city approved plans.
2 ; complete vert. rebar as per city approved plans at grid line - (A-B,1-3.5)
3 ; complete pier pads at grid line -(G-H,4-5) (5,b.5) (A,5-6) not completed at time of inspection.
4 ; provide detail from engineer of record for step at grid line - (1.c.5)
|
||||
Foundation/Rebar Inspection | Not Ready | 8/24/2023 | 8/24/2023 | 08/24/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
08/24/2023
1 ; no foundation walls ready for inspection. ( footings only)
|
||||
Foundation/Rebar Inspection | Partial Pass | 8/25/2023 | 8/25/2023 | 08/25/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/25/2023
1. provide letter for no changes needed at step in foundation from engineer of record
2. ok to pour per special inspection approval footings only
|
||||
Plumbing Rough In Inspection | Partial Pass | 8/31/2023 | 8/31/2023 | 09/01/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/01/2023
1. under slab plumbing inspection
2.storm line, sewer line, parking garage drains approved as marked up on sheet P-200 of city approved plans
3.use clean backfill as discussed with plumber
|
||||
Foundation/Rebar Inspection | Not Ready | 9/13/2023 | 9/13/2023 | 09/13/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/13/2023
1 ; no foundation walls ready for inspection. ( footings only)
|
||||
Other/Miscellaneous
Carried Forward
09/13/2023
1 ; cancel per contractor - not ready
|
||||
Foundation/Rebar Inspection | Partial Pass | 9/14/2023 | 9/14/2023 | 09/14/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/14/2023
1. provide letter for no changes needed at step in foundation from engineer of record
2. ok to pour per special inspection approval footings only
|
||||
Plumbing Rough In Inspection | Failed | 9/27/2023 | 9/27/2023 | 09/27/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/27/2023
1. under slab plumbing inspection
2.storm line, sewer line, parking garage drains approved as marked up on sheet P-200 of city approved plans
3.use clean backfill as discussed with plumber
|
||||
Other/Miscellaneous
Carried Forward
09/27/2023
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Plumbing Rough In Inspection | Partial Pass | 9/28/2023 | 9/28/2023 | 09/28/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/28/2023
1. under slab plumbing inspection
2.storm line, sewer line, parking garage drains approved as marked up on sheet P-200 of city approved plans
3.use clean backfill as discussed with plumber
|
||||
Other/Miscellaneous
Carried Forward
09/28/2023
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
09/28/2023
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Foundation/Rebar Inspection | Failed | 10/4/2023 | 10/4/2023 | 10/04/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
10/04/2023
1 ; no foundation walls ready for inspection. ( footings only)
|
||||
Other/Miscellaneous
Carried Forward
10/04/2023
1 ; cancel per contractor - not ready
|
||||
Other/Miscellaneous
Carried Forward
10/04/2023
1.10/4/2023 inspection date 1. provide inspection reports from special inspection as well as geotech of record approval for the reports for soil bearing compaction for footing being poured per city approved S sheets
1. DO NOT POUR
|
||||
Foundation/Rebar Inspection | Partial Pass | 10/6/2023 | 10/6/2023 | 10/06/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
10/06/2023
1 ; no foundation walls ready for inspection. ( footings only)
|
||||
Other/Miscellaneous
Carried Forward
10/06/2023
1 ; cancel per contractor - not ready
|
||||
Other/Miscellaneous
Resolved
10/06/2023
1.10/4/2023 inspection date 1. provide inspection reports from special inspection as well as geotech of record approval for the reports for soil bearing compaction for footing being poured per city approved S sheets
1. DO NOT POUR
|
||||
Foundation/Rebar Inspection | Partial Pass | 10/11/2023 | 10/11/2023 | 10/11/2023 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
09/14/2023
1. provide letter for no changes needed at step in foundation from engineer of record
2. ok to pour per special inspection approval footings only
|
||||
Plumbing Final Inspection | Partial Pass | 11/28/2023 | 11/28/2023 | 11/28/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
11/28/2023
1. plumbing under slab approved as marked on city approved plans page p 2.0
|
||||
Foundation/Rebar Inspection | Partial Pass | 12/27/2023 | 12/27/2023 | 12/27/2023 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Resolved
12/27/2023
1 ; no foundation walls ready for inspection. ( footings only)
|
||||
Other/Miscellaneous
Resolved
12/27/2023
1 ; cancel per contractor - not ready
|
||||
Other/Miscellaneous
Carried Forward
12/27/2023
1st floor resident slab ok to pour with special insp.
|
||||
Shear Wall Inspection | Partial Pass | 1/5/2024 | 1/5/2024 | 01/05/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
01/05/2024
1:north ext and west ext 2nd floor shear ok with special insp approval on 4" oc walls
|
||||
Shear Wall Inspection | Passed w/ Conditions | 1/10/2024 | 1/10/2024 | 01/10/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
01/10/2024
approved with special insp approval and abutting edges stiched up
|
||||
Frame Inspection | Not Ready | 1/17/2024 | 1/17/2024 | 01/17/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
01/17/2024
1.provide special inspection reports on site at time of next inspection
2.not ready
|
||||
Shear Wall Inspection | Passed w/ Conditions | 1/18/2024 | 1/18/2024 | 01/18/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
01/18/2024
1:recieved special insp report for third floor ext walls
PROVIDE ENGINEER OF RECORDS OSB THRU RIM JOIST DETAIL FOR EXTERIOR WALLS
|
||||
Frame Inspection | Passed w/ Conditions | 1/30/2024 | 1/30/2024 | 01/30/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
01/30/2024
1.provide special inspection reports on site at time of next inspection
2.not ready
|
||||
Other/Miscellaneous
Outstanding
01/30/2024
4th floor shear apporval pending 3rd party reports
|
||||
Roof Sheathing Inspection | Partial Pass | 2/7/2024 | 2/7/2024 | 02/07/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
02/07/2024
A to G, 3 to 6 line roof sheathing ok
|
||||
Roof Sheathing Inspection | Partial Pass | 2/13/2024 | 2/13/2024 | 02/13/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
02/13/2024
recieved special insp report for roof sheathing to include all straps and clips for parapet
|
||||
Wallboard / Drywall Inspection | Partial Pass | 2/13/2024 | 2/13/2024 | 02/13/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
02/13/2024
dense glass on parapet ok, received rfi on non balloon framed parapet
|
||||
Plumbing Rough In Inspection | Partial Pass | 2/26/2024 | 2/26/2024 | 02/26/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
02/26/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
02/26/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
02/26/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Comment Building Div Inspection | Not Ready | 2/26/2024 | 2/26/2024 | 02/26/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
02/26/2024
1 ; provide full set of City approved plans on-site at time of inspection.
2 ; provide all geo-tech and special inspection reports at time of building inspection.
not ready
|
||||
Energy (Insulation) Inspection | Partial Pass | 2/28/2024 | 2/28/2024 | 02/28/2024 |
Shannon King ((253) 840-6684) | ||||
Roof Sheathing Inspection | Partial Pass | 2/29/2024 | 2/29/2024 | 02/29/2024 |
Shannon King ((253) 840-6684) | ||||
Comment Building Div Inspection | Not Ready | 3/1/2024 | 3/1/2024 | 03/01/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
03/01/2024
1 ; provide full set of City approved plans on-site at time of inspection.
2 ; provide all geo-tech and special inspection reports at time of building inspection.
not ready
|
||||
Comment Building Div Inspection | Not Ready | 3/18/2024 | 3/18/2024 | 03/18/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
03/18/2024
1 ; provide full set of City approved plans on-site at time of inspection.
2 ; provide all geo-tech and special inspection reports at time of building inspection.
not ready
|
||||
Comment Building Div Inspection | Partial Pass | 3/22/2024 | 3/22/2024 | 03/22/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
03/22/2024
1 ; provide full set of City approved plans on-site at time of inspection.
2 ; provide all geo-tech and special inspection reports at time of building inspection.
not ready
|
||||
Other/Miscellaneous
Carried Forward
03/22/2024
1:recieved special insp approval for 3/4" all thread epoxied for holdown in first floor break room
|
||||
Comment Building Div Inspection | Partial Pass | 3/27/2024 | 3/27/2024 | 03/27/2024 |
Shannon King ((253) 840-6684) | ||||
Shear Wall Inspection | Not Ready | 3/28/2024 | 3/28/2024 | 03/28/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 4/2/2024 | 4/2/2024 | 04/02/2024 |
Shannon King ((253) 840-6684) | ||||
Plumbing Rough In Inspection | Partial Pass | 4/4/2024 | 4/4/2024 | 04/04/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
04/04/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
04/04/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
04/04/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Wallboard / Drywall Inspection | Not Ready | 4/9/2024 | 4/9/2024 | 04/09/2024 |
Shannon King ((253) 840-6684) | ||||
Mechanical Rough In Inspection | Not Ready | 4/11/2024 | 4/11/2024 | 04/11/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 4/11/2024 | 4/11/2024 | 04/11/2024 |
Shannon King ((253) 840-6684) | ||||
Plumbing Rough In Inspection | Not Ready | 4/29/2024 | 4/29/2024 | 04/29/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
04/29/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
04/29/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
04/29/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Cover Inspection/Thrust Blocks Inspection | VOID | 4/29/2024 | 04/30/2024 | |
Michael Rosenau ((253) 344-6753) | ||||
Shear Wall Inspection | Passed w/ Conditions | 5/2/2024 | 5/2/2024 | 05/02/2024 |
Shannon King ((253) 840-6684) | ||||
Ceiling Grid/T-Bar Inspection | Not Ready | 5/6/2024 | 5/6/2024 | 05/06/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 5/6/2024 | 5/6/2024 | 05/06/2024 |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Not Ready | 5/13/2024 | 5/13/2024 | 05/13/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/13/2024
inspection of unit 453
1 ; complete all firestop and draftstop as discussed with contractor.
2 ; complete engineers approved of TJI"S not install as per plans.
3 ; provide structural engineers observation report prior to next inspection.
4 ; provide rated access doors for shutoff valves in rated ceiling.
5 ; complete putty packs at electrical boxes and draft stop at 10' o.c. at party walls as discussed with contractor.
5 ;complete 6''x10'' headers as per plans or provide engineers as-built approval.
6 ; complete all items in other units as discussed with contractor prior to next inspection.
( bathrooms will be inspected at a later date as requested per contractor at additional fee of $180 as discussed with contractor)
|
||||
Energy (Insulation) Inspection | Not Ready | 5/14/2024 | 5/14/2024 | 05/14/2024 |
Shannon King ((253) 840-6684) | ||||
Plumbing Rough In Inspection | Partial Pass | 5/20/2024 | 5/20/2024 | 05/20/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/20/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
05/20/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
05/20/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Energy (Insulation) Inspection | Not Ready | 5/20/2024 | 5/20/2024 | 05/20/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/20/2024
1 ; complete all draftstop at floors - 4&3 as discussed with contractor ( floor 2 canceled per contractor) not ready
|
||||
Frame Inspection | Partial Pass | 5/20/2024 | 5/20/2024 | 05/20/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
05/20/2024
1 ; tighten nuts on all hold downs as discussed with contractor. ( not ready)
ok to install drywall on o.s.b. side of party walls only at 3rd &4th floor only.
|
||||
Footing/Setback Inspection | Partial Pass | 5/21/2024 | 5/21/2024 | 05/21/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
05/21/2024
1 ; provide Geo-tech approval for soil bearing of 4,000 psf as required per structural sheets of city approved plans.
2 ; complete vert. rebar as per city approved plans at grid line - (A-B,1-3.5)
3 ; complete pier pads at grid line -(G-H,4-5) (5,b.5) (A,5-6) not completed at time of inspection.
4 ; provide detail from engineer of record for step at grid line - (1.c.5)
|
||||
Energy (Insulation) Inspection | Failed | 5/23/2024 | 5/23/2024 | 05/23/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/23/2024
1 ; complete all insulation at areas of ceiling as discussed with contractor.
not ready
|
||||
Frame Inspection | Partial Pass | 5/23/2024 | 5/23/2024 | 05/23/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/23/2024
inspection of unit 453
1 ; complete all firestop and draftstop as discussed with contractor.
2 ; complete engineers approved of TJI"S not install as per plans.
3 ; provide structural engineers observation report prior to next inspection.
4 ; provide rated access doors for shutoff valves in rated ceiling.
5 ; complete putty packs at electrical boxes and draft stop at 10' o.c. at party walls as discussed with contractor.
5 ;complete 6''x10'' headers as per plans or provide engineers as-built approval.
6 ; complete all items in other units as discussed with contractor prior to next inspection.
( bathrooms will be inspected at a later date as requested per contractor at additional fee of $180 as discussed with contractor)
|
||||
Other/Miscellaneous
Carried Forward
05/23/2024
inspection of 4th floor framing. (except stairwell ,3' of south corridor,and all restrooms)
1 ; complete engineers approved of TJI"S not install as per plans.
2 ; provide structural engineers observation prior to next inspection.
3; provide rated access doors for shutoff valves in rated ceiling.
( bathrooms will be inspected at a later date as requested per contractor at additional fee of $180 as discussed with contractor)
inspection of 2nd floor framing. (except stairwell ,3' of south corridor,and all restrooms)
corridors - 1 ; complete all anchor bolts in corridor.
2. complete nail plates at sprinkler pipes,
3.complete draftstop at 10'o.c. at ceiling.
unit 261 - 1.seal penetration in top plate at n.w corner of unit.
2.complete draftstop at 10 o.c. at ceiling.
unit 260 - tighten nut on hold downs at n.e. corner unit.
unit 259 - tighten nut on hold downs at east wall.
unit 258 - tighten nut on hold downs.at east wall.
unit 257- 1.tighten nut on hold downs at east wall.
2.complete nailing of A35's at south wall at 7th bay from west wall.
unit 253 -1. provide positive attachment of beam to wall.
2.provide squash blocks at beam.
3 ; complete firestop at top plate at east wall.
|
||||
Energy (Insulation) Inspection | Partial Pass | 5/24/2024 | 5/24/2024 | 05/24/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/24/2024
1 ; complete all draftstop at floors - 4&3 as discussed with contractor ( floor 2 canceled per contractor) not ready
|
||||
Frame Inspection | Partial Pass | 5/28/2024 | 5/28/2024 | 05/28/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
05/28/2024
inspection of 4th floor framing complete.(except stairwell ,3' of south corridor, and all restrooms)
inspection of 3th floor framing .(except stairwell ,3' of south corridor, and all restrooms)
1 ; unit 360 - complete firestop at north wall.
2; 357 tighten nut on hold down
3 ; complete firestop at south wall.
4 ; insulate all hot water lines as discussed with contractor.
inspection of 2th floor framing .(except stairwell ,3' of south corridor, and all restrooms)
1 ; complete anchor bolts in corridor. (min. 2 bolts per plate)
2 ; 253 provide positive attachment og beam to wall.
2 ; provide squash blocks at beam
|
||||
Energy (Insulation) Inspection | Partial Pass | 5/29/2024 | 5/29/2024 | 05/29/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
05/29/2024
1 ; complete all insulation at areas of ceiling as discussed with contractor.
not ready
|
||||
Exhaust/Vent Fans Inspection | Partial Pass | 5/30/2024 | 5/30/2024 | 05/30/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 5/30/2024 | 5/30/2024 | 05/30/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
05/30/2024
1 ; complete all draftstop at floors - 4&3 as discussed with contractor ( floor 2 canceled per contractor) not ready
|
||||
Energy (Insulation) Inspection | Partial Pass | 6/3/2024 | 6/3/2024 | 06/03/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Not Ready | 6/4/2024 | 6/4/2024 | 06/04/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Not Ready | 6/4/2024 | 6/4/2024 | 06/04/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
06/04/2024
1 ;Provide install details for Level 3&4 Resilient Channel Systems at time of inspection. ( not ready)
|
||||
Exhaust/Vent Fans Inspection | Partial Pass | 6/4/2024 | 6/4/2024 | 06/04/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 6/5/2024 | 6/5/2024 | 06/05/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/5/2024 | 6/5/2024 | 06/05/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
06/05/2024
1 ;Provide install details for Level 3&4 Resilient Channel Systems at time of inspection. ( not ready)
|
||||
Other/Miscellaneous
Carried Forward
06/05/2024
Level 3 & Level 4 Resilient Channel System except rooms 360,460,south end of corridors.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/6/2024 | 6/6/2024 | 06/06/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
06/06/2024
1 ; complete all drywall nailing as discussed with contractor at 1st layer of 3rd floor. not ready
|
||||
Plumbing Rough In Inspection | Partial Pass | 6/7/2024 | 6/7/2024 | 06/07/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
06/07/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
06/07/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
06/07/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/7/2024 | 6/7/2024 | 06/07/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/8/2024 | 06/08/2024 | |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Partial Pass | 6/8/2024 | 06/08/2024 | |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/11/2024 | 6/11/2024 | 06/11/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
06/05/2024
Level 3 & Level 4 Resilient Channel System except rooms 360,460,south end of corridors.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/13/2024 | 6/13/2024 | 06/13/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
06/06/2024
1 ; complete all drywall nailing as discussed with contractor at 1st layer of 3rd floor. not ready
|
||||
Frame Inspection | Failed | 6/13/2024 | 6/13/2024 | 06/13/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
06/13/2024
inspection of unit 453
1 ; complete all firestop and draftstop as discussed with contractor.
2 ; complete engineers approved of TJI"S not install as per plans.
3 ; provide structural engineers observation report prior to next inspection.
4 ; provide rated access doors for shutoff valves in rated ceiling.
5 ; complete putty packs at electrical boxes and draft stop at 10' o.c. at party walls as discussed with contractor.
5 ;complete 6''x10'' headers as per plans or provide engineers as-built approval.
6 ; complete all items in other units as discussed with contractor prior to next inspection.
( bathrooms will be inspected at a later date as requested per contractor at additional fee of $180 as discussed with contractor)
|
||||
Other/Miscellaneous
Resolved
06/13/2024
inspection of 4th floor framing. (except stairwell ,3' of south corridor,and all restrooms)
1 ; complete engineers approved of TJI"S not install as per plans.
2 ; provide structural engineers observation prior to next inspection.
3; provide rated access doors for shutoff valves in rated ceiling.
( bathrooms will be inspected at a later date as requested per contractor at additional fee of $180 as discussed with contractor)
inspection of 2nd floor framing. (except stairwell ,3' of south corridor,and all restrooms)
corridors - 1 ; complete all anchor bolts in corridor.
2. complete nail plates at sprinkler pipes,
3.complete draftstop at 10'o.c. at ceiling.
unit 261 - 1.seal penetration in top plate at n.w corner of unit.
2.complete draftstop at 10 o.c. at ceiling.
unit 260 - tighten nut on hold downs at n.e. corner unit.
unit 259 - tighten nut on hold downs at east wall.
unit 258 - tighten nut on hold downs.at east wall.
unit 257- 1.tighten nut on hold downs at east wall.
2.complete nailing of A35's at south wall at 7th bay from west wall.
unit 253 -1. provide positive attachment of beam to wall.
2.provide squash blocks at beam.
3 ; complete firestop at top plate at east wall.
|
||||
Other/Miscellaneous
Outstanding
06/13/2024
Framing of Stair tower @ level 1-4 framing only.
1. complete nailing of all hangers.
2 ; provide engineering detail for roof framing at roof top access as discussed with contractor.
3 ; provide positive attachment of rafters to top plans.
4 ; complete backing of handrail at both sides of stairs.
5 ; contractor to check stairs do not exceed 7'' rise or 3/8'' differance in rise by final.
|
||||
Energy (Insulation) Inspection | Not Ready | 6/13/2024 | 6/13/2024 | 06/13/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 6/15/2024 | 6/15/2024 | 06/17/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/17/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/15/2024 | 6/15/2024 | 06/17/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/17/2024
date of inspection 6/15/2024
LEVEL 4
1.corridor ceiling 2nd layer approved
2.bathroom ceiling and walls first layer approved
LEVEL 3
1. corridor ceiling 2nd layer approved
2.bathroom ceiling and walls first layer approved except room 361,and 362
LEVEL 2
corridor ceiling 1st layer approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/21/2024 | 6/21/2024 | 06/21/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/21/2024 | 6/21/2024 | 06/21/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
06/21/2024
1 ; inspection of 2nd layer of drywall complete at level 4 bathroom ,rooms . (except mechanical chase ,and shafts.)
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/22/2024 | 06/23/2024 | |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
06/23/2024
1 ; drywall nailing of 1st layer at 2nd floor complete except - 253, shower wall at valve and chase,260 shower wall at valve and chase,261 shower wall at valve and chase,262 shower wall at valve and chase,360 except shower, 361 & 362 1st layer except bathroom shower wall.
2 ; drywall nailing of 2nd layer at rooms 358,except furred wall and chase,357 except furred wall and chase,355 except furred wall and chase,354 except furred wall and chase, 353 except furred wall and chase.
3 ; drywall nailing of 2nd layer at 4th floor complete except 460 shower valve wall and chase,461 shower valve wall and chase,
|
||||
Wallboard / Drywall Inspection | Not Ready | 6/24/2024 | 6/24/2024 | 06/24/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/25/2024 | 6/25/2024 | 06/25/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
06/17/2024
date of inspection 6/15/2024
LEVEL 4
1.corridor ceiling 2nd layer approved
2.bathroom ceiling and walls first layer approved
LEVEL 3
1. corridor ceiling 2nd layer approved
2.bathroom ceiling and walls first layer approved except room 361,and 362
LEVEL 2
corridor ceiling 1st layer approved
|
||||
Other/Miscellaneous
Outstanding
06/25/2024
L4: Ceiling of CHASE First Layer
L3: Ceiling of Chase First Layer
L2: Ceiling of Chase First Layer
complete all areas as discussed with contractor . (failed)
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/26/2024 | 6/26/2024 | 06/26/2024 |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Not Ready | 6/27/2024 | 6/27/2024 | 06/27/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
06/27/2024
inspection of 4th floor framing complete.(except stairwell ,3' of south corridor, and all restrooms)
inspection of 3th floor framing .(except stairwell ,3' of south corridor, and all restrooms)
1 ; unit 360 - complete firestop at north wall.
2; 357 tighten nut on hold down
3 ; complete firestop at south wall.
4 ; insulate all hot water lines as discussed with contractor.
inspection of 2th floor framing .(except stairwell ,3' of south corridor, and all restrooms)
1 ; complete anchor bolts in corridor. (min. 2 bolts per plate)
2 ; 253 provide positive attachment og beam to wall.
2 ; provide squash blocks at beam
|
||||
Other/Miscellaneous
Outstanding
06/27/2024
cancel per Bill.
|
||||
Frame Inspection | Not Ready | 6/28/2024 | 6/28/2024 | 06/28/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/28/2024
1. cancelled on site by contractor
|
||||
Wallboard / Drywall Inspection | Not Ready | 6/28/2024 | 6/28/2024 | 06/28/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Outstanding
06/28/2024
1.cancelled on site by contractor
|
||||
Firewall/Firestop Inspection | Not Ready | 7/1/2024 | 7/1/2024 | 07/01/2024 |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Not Ready | 7/1/2024 | 7/1/2024 | 07/01/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/1/2024 | 7/1/2024 | 07/01/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/01/2024
1 ; drywall nailing of 1st layer at 2nd floor complete except - 253, shower wall at valve and chase,260 shower wall at valve and chase,261 shower wall at valve and chase,262 shower wall at valve and chase,360 except shower, 361 & 362 1st layer except bathroom shower wall.
2 ; drywall nailing of 2nd layer at rooms 358,except furred wall and chase,357 except furred wall and chase,355 except furred wall and chase,354 except furred wall and chase, 353 except furred wall and chase.
3 ; drywall nailing of 2nd layer at 4th floor complete except 460 shower valve wall and chase,461 shower valve wall and chase,
|
||||
Comment Building Div Inspection | Not Ready | 7/2/2024 | 7/2/2024 | 07/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/02/2024
cancelled by contractor
|
||||
Plumbing Rough In Inspection | Not Ready | 7/2/2024 | 7/2/2024 | 07/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/02/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
date of inspection 7/2/2024
1.cancelled on site by contractor
|
||||
Frame Inspection | Not Ready | 7/2/2024 | 7/2/2024 | 07/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/02/2024
1.complete framing at soffits per detail
2.not ready
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/3/2024 | 7/3/2024 | 07/03/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/03/2024
1 ; drywall nailing of 1st layer at 2nd floor complete except - 253, shower wall at valve and chase,260 shower wall at valve and chase,261 shower wall at valve and chase,262 shower wall at valve and chase,360 except shower, 361 & 362 1st layer except bathroom shower wall.
2 ; drywall nailing of 2nd layer at rooms 358,except furred wall and chase,357 except furred wall and chase,355 except furred wall and chase,354 except furred wall and chase, 353 except furred wall and chase.
3 ; drywall nailing of 2nd layer at 4th floor complete except 460 shower valve wall and chase,461 shower valve wall and chase,
|
||||
Frame Inspection | Partial Pass | 7/3/2024 | 7/3/2024 | 07/03/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 7/3/2024 | 7/3/2024 | 07/03/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/03/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Plumbing Final Inspection | Partial Pass | 7/3/2024 | 7/3/2024 | 07/05/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/05/2024
1. plumbing under slab approved as marked on city approved plans page p 2.0
|
||||
Frame Inspection | Partial Pass | 7/5/2024 | 7/5/2024 | 07/05/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/05/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Outstanding
07/05/2024
1:drop cielings in corridors on 3rd and 4th floor ok
2:firred walls in bathrooms ok with hot water lines insulated level 3 and 4
3:holdowns at end of corridor to have special inspections as per plan
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/5/2024 | 7/5/2024 | 07/05/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/05/2024
mud and tape at drop cieling areas in corridor at 2nd level ok and behind firred walls 3rd and 4th floors
|
||||
Plumbing Rough In Inspection | Partial Pass | 7/5/2024 | 7/5/2024 | 07/05/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/05/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
07/05/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
07/05/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Other/Miscellaneous
Carried Forward
07/05/2024
date of inspection 7/2/2024
1.cancelled on site by contractor
|
||||
Other/Miscellaneous
Carried Forward
07/05/2024
ok to insulate hw lines at showers and tubs 3rd and 4th floor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/6/2024 | 07/07/2024 | |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Partial Pass | 7/8/2024 | 7/8/2024 | 07/08/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
07/08/2024
1.complete framing at soffits per detail
2.not ready
|
||||
Other/Miscellaneous
Carried Forward
07/08/2024
1 ;inspection of stack 39 shear walls at east side only. -( tighten nuts on hold downs,and complete firestop at top plate penetrations as discussed with contractor.) not ready
2 ; contractor requested at drywall inspection at time of inspection for1st layer at south side of corridor at floors 1-3 complete.
|
||||
Frame Inspection | Partial Pass | 7/9/2024 | 7/9/2024 | 07/09/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Not Ready | 7/9/2024 | 7/9/2024 | 07/09/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 7/10/2024 | 7/10/2024 | 07/10/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/10/2024 | 7/10/2024 | 07/10/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/12/2024 | 7/12/2024 | 07/13/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/13/2024
1 ; drywall nailing of 1st layer at 2nd floor complete except - 253, shower wall at valve and chase,260 shower wall at valve and chase,261 shower wall at valve and chase,262 shower wall at valve and chase,360 except shower, 361 & 362 1st layer except bathroom shower wall.
2 ; drywall nailing of 2nd layer at rooms 358,except furred wall and chase,357 except furred wall and chase,355 except furred wall and chase,354 except furred wall and chase, 353 except furred wall and chase.
3 ; drywall nailing of 2nd layer at 4th floor complete except 460 shower valve wall and chase,461 shower valve wall and chase,
|
||||
Other/Miscellaneous
Carried Forward
07/13/2024
date of inspection 7/12/2024
4th FLOOR
1.corridor at tie in to existing building walls approved and 1rst layer at ceiling approved
2. corridor side of rated wall at stairs provide min off sets per listing for second layer of drywall
3rd FLOOR
1.corridor at tie in to existing building walls approved and 1rst layer at ceiling approved
2. corridor side of rated wall at stairs provide min off sets per listing for second layer of drywall
2nd FLOOR
1.corridor at tie in to existing building walls approved and first layer at ceiling approved
|
||||
Frame Inspection | Failed | 7/12/2024 | 7/12/2024 | 07/13/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/13/2024
date of inspection 7/12/2024
2nd FLOOR
1. provide straps at plat breaks
2. provide nail plates at plumbing
3.secure water lines
|
||||
Plumbing Rough In Inspection | Failed | 7/12/2024 | 7/12/2024 | 07/13/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/13/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing.
2 ; test failed on below slab plumbing. ( no 10' head test at time of inspection)
|
||||
Other/Miscellaneous
Carried Forward
07/13/2024
1 ; provide as built plumbing plan approval from mechanical engineer for changes to below slab plumbing prior to below slab plumbing approval . (inspection of below slab plumbing only)
|
||||
Other/Miscellaneous
Carried Forward
07/13/2024
1 ; complete rough-in of water supply as discussed with contractor.
2 ; approved test on d.w.v.
|
||||
Other/Miscellaneous
Carried Forward
07/13/2024
date of inspection 7/2/2024
1.cancelled on site by contractor
|
||||
Other/Miscellaneous
Carried Forward
07/13/2024
date of inspection 7/12/2024
2nd FLOOR
1.provide nail plates at plumbing
2.secure water lines at shower valves
|
||||
Frame Inspection | Failed | 7/12/2024 | 7/12/2024 | 07/13/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/13/2024
1 ;inspection of stack 39 shear walls at east side only. -( tighten nuts on hold downs,and complete firestop at top plate penetrations as discussed with contractor.) not ready
2 ; contractor requested at drywall inspection at time of inspection for1st layer at south side of corridor at floors 1-3 complete.
|
||||
Other/Miscellaneous
Carried Forward
07/13/2024
date of inspection 7/12/2024
2nd FLOOR
1. at clouds complete framing per detail sheet
2.provide fire cover approval prior to scheduling this inspection
|
||||
Frame Inspection | Partial Pass | 7/16/2024 | 7/16/2024 | 07/16/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/16/2024 | 7/16/2024 | 07/16/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/16/2024 | 7/16/2024 | 07/16/2024 |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Failed | 7/17/2024 | 7/17/2024 | 07/17/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
07/17/2024
1 ;inspection of stack 39 shear walls at east side only. -( tighten nuts on hold downs,and complete firestop at top plate penetrations as discussed with contractor.) not ready
2 ; contractor requested at drywall inspection at time of inspection for1st layer at south side of corridor at floors 1-3 complete.
|
||||
Other/Miscellaneous
Resolved
07/17/2024
date of inspection 7/12/2024
2nd FLOOR
1. at clouds complete framing per detail sheet
2.provide fire cover approval prior to scheduling this inspection
|
||||
Other/Miscellaneous
Carried Forward
07/17/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/17/2024 | 7/17/2024 | 07/17/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/23/2024 | 7/23/2024 | 07/23/2024 |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Partial Pass | 7/23/2024 | 7/23/2024 | 07/23/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
07/23/2024
date of inspection 7/12/2024
2nd FLOOR
1. provide straps at plat breaks
2. provide nail plates at plumbing
3.secure water lines
|
||||
Energy (Insulation) Inspection | Partial Pass | 7/24/2024 | 7/24/2024 | 07/24/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 7/25/2024 | 7/25/2024 | 07/25/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Failed | 7/30/2024 | 7/30/2024 | 07/30/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/30/2024
1. complete fastening of drywall as discussed with contractor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/31/2024 | 7/31/2024 | 08/01/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Outstanding
07/13/2024
1 ; drywall nailing of 1st layer at 2nd floor complete except - 253, shower wall at valve and chase,260 shower wall at valve and chase,261 shower wall at valve and chase,262 shower wall at valve and chase,360 except shower, 361 & 362 1st layer except bathroom shower wall.
2 ; drywall nailing of 2nd layer at rooms 358,except furred wall and chase,357 except furred wall and chase,355 except furred wall and chase,354 except furred wall and chase, 353 except furred wall and chase.
3 ; drywall nailing of 2nd layer at 4th floor complete except 460 shower valve wall and chase,461 shower valve wall and chase,
|
||||
Other/Miscellaneous
Outstanding
07/13/2024
date of inspection 7/12/2024
4th FLOOR
1.corridor at tie in to existing building walls approved and 1rst layer at ceiling approved
2. corridor side of rated wall at stairs provide min off sets per listing for second layer of drywall
3rd FLOOR
1.corridor at tie in to existing building walls approved and 1rst layer at ceiling approved
2. corridor side of rated wall at stairs provide min off sets per listing for second layer of drywall
2nd FLOOR
1.corridor at tie in to existing building walls approved and first layer at ceiling approved
|
||||
Other/Miscellaneous
Outstanding
08/01/2024
1.2nd layer approved at stairwell at door wall
2.head of shower walls on 2nd floor units approved
|
||||
Foundation/Rebar Inspection | Not Ready | 8/1/2024 | 8/1/2024 | 08/01/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/01/2024
called in in error
|
||||
Wallboard / Drywall Inspection | Partial Pass | 8/6/2024 | 8/6/2024 | 08/07/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/07/2024
date of inspection 8/6/2024
1.drywall approved at concrete walls in stairwells
|
||||
Energy (Insulation) Inspection | Partial Pass | 8/6/2024 | 8/6/2024 | 08/07/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/07/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Other/Miscellaneous
Carried Forward
08/07/2024
date of inspection 8/6/2024
1. rock wool at 4th floor ceiling in rated mech shaft approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 8/7/2024 | 8/7/2024 | 08/07/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Outstanding
08/07/2024
date of inspection 8/7/2024
1.north walls of rooms 460, 360 and 260 2nd layer at rated stair wall approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 8/8/2024 | 8/8/2024 | 08/08/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/08/2024
date of inspection 8/8/2024
1.1 sheet of drywall at stair stringers at bottom of stairs first layer approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 8/12/2024 | 8/12/2024 | 08/12/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
08/12/2024
1. complete fastening of drywall as discussed with contractor
|
||||
Firewall/Firestop Inspection | Not Ready | 8/19/2024 | 8/19/2024 | 08/19/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 8/21/2024 | 8/21/2024 | 08/21/2024 |
Shannon King ((253) 840-6684) | ||||
Frame Inspection | Not Ready | 8/26/2024 | 8/26/2024 | 08/26/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/26/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Carried Forward
08/26/2024
NO ONE ON SITE AT TIME OF INSPECTION 11:15 AM
|
||||
Frame Inspection | Not Ready | 8/27/2024 | 8/27/2024 | 08/27/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Outstanding
08/27/2024
1. provide supporting documentation to support inspection to be performed on site at time of next inspection
2.not ready
|
||||
Frame Inspection | Partial Pass | 8/28/2024 | 8/28/2024 | 08/29/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/29/2024
date of inspection 8/28/2024
1.stack 39 floor 3 and 4 complete header install at new opening to existing corridor per detail
2.complete fire stopping
3. ok to insulate
GARAGE AREA
1. rockwool at pipe penetration's approved
2.provide documentation to support repair of holes with no pipe in them
|
||||
Energy (Insulation) Inspection | Partial Pass | 8/29/2024 | 8/29/2024 | 08/30/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 8/29/2024
1. level 4 stack 39 ceiling in corridor ok to cover
2.level 3 stack 39 ceiling in corridor ok to cover except in area where plumbing is not complete
|
||||
Frame Inspection | Not Ready | 8/29/2024 | 8/29/2024 | 08/30/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/30/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Carried Forward
08/30/2024
NO ONE ON SITE AT TIME OF INSPECTION 11:15 AM
|
||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 8/29/2024
1.complete header framing per detail at stack 39 corridor on 2nd 3rd 4th floors
|
||||
Frame Inspection | Not Ready | 8/29/2024 | 8/29/2024 | 08/30/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 8/29/2024
existing building meeting room
1.complete framing
2. complete fire stop
3. complete electrical R/I and provide electrical cover approval at time of next inspection
4. not a complete list
|
||||
Energy (Insulation) Inspection | Partial Pass | 8/30/2024 | 8/30/2024 | 08/30/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 8/6/2024
1. rock wool at 4th floor ceiling in rated mech shaft approved
|
||||
Other/Miscellaneous
Carried Forward
08/30/2024
1. fire stop at plumbing in parking garage area approved
|
||||
Frame Inspection | Partial Pass | 8/30/2024 | 8/30/2024 | 08/30/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 8/28/2024
1.stack 39 floor 3 and 4 complete header install at new opening to existing corridor per detail
2.complete fire stopping
3. ok to insulate
GARAGE AREA
1. rockwool at pipe penetration's approved
2.provide documentation to support repair of holes with no pipe in them
|
||||
Other/Miscellaneous
Carried Forward
08/30/2024
date of inspection 8/30/2024
1.stack 39 header at corridor 2nd 3rd 4th floors approved
2. stack 39 2nd level corridor ok to cover ceiling only
|
||||
Ceiling Grid/T-Bar Inspection | Not Ready | 9/3/2024 | 9/3/2024 | 09/03/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/03/2024
1 ; complete install of lights and electrical cover approval prior to ceiling grid inspection at floor 2-4 as discussed with contractor.
not ready
|
||||
Energy (Insulation) Inspection | Not Ready | 9/3/2024 | 9/3/2024 | 09/03/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Not Ready | 9/3/2024 | 9/3/2024 | 09/03/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/03/2024
date of inspection 8/6/2024
1.drywall approved at concrete walls in stairwells
|
||||
Frame Inspection | Not Ready | 9/4/2024 | 9/4/2024 | 09/04/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/04/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Carried Forward
09/04/2024
NO ONE ON SITE AT TIME OF INSPECTION 11:15 AM
|
||||
Other/Miscellaneous
Carried Forward
09/04/2024
date of inspection 8/29/2024
1.complete header framing per detail at stack 39 corridor on 2nd 3rd 4th floors
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/4/2024 | 9/4/2024 | 09/04/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 9/4/2024 | 9/4/2024 | 09/04/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/04/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Other/Miscellaneous
Carried Forward
09/04/2024
date of inspection 8/6/2024
1. rock wool at 4th floor ceiling in rated mech shaft approved
|
||||
Other/Miscellaneous
Carried Forward
09/04/2024
1. fire stop at plumbing in parking garage area approved
|
||||
Energy (Insulation) Inspection | Not Ready | 9/4/2024 | 9/4/2024 | 09/04/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
08/30/2024
date of inspection 8/29/2024
1. level 4 stack 39 ceiling in corridor ok to cover
2.level 3 stack 39 ceiling in corridor ok to cover except in area where plumbing is not complete
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/5/2024 | 9/5/2024 | 09/05/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/05/2024
date of inspection 8/8/2024
1.1 sheet of drywall at stair stringers at bottom of stairs first layer approved
|
||||
Energy (Insulation) Inspection | Not Ready | 9/6/2024 | 9/6/2024 | 09/09/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/09/2024
date of inspection 9/6/202024
1.no energy was approved
|
||||
Wallboard / Drywall Inspection | Not Ready | 9/6/2024 | 9/6/2024 | 09/09/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/09/2024
1. complete fastening of drywall as discussed with contractor
|
||||
Other/Miscellaneous
Carried Forward
09/09/2024
date of inspection 9/6/2024
1. 2nd floor stack 39 west wall of corridor and ceiling complete nailing of drywall as discussed with contractor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/6/2024 | 9/6/2024 | 09/09/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/09/2024
date of inspection 9/6/2024
1.level 4 stack 39 corridor ceiling 2nd layer approved
2. level 4 stack 39 corridor west wall 2nd layer stagger was started off sets looked ok
|
||||
Frame Inspection | Not Ready | 9/6/2024 | 9/6/2024 | 09/09/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/09/2024
date of inspection 8/29/2024
existing building meeting room
1.complete framing
2. complete fire stop
3. complete electrical R/I and provide electrical cover approval at time of next inspection
4. not a complete list
|
||||
Mechanical Rough In Inspection | Not Ready | 9/9/2024 | 9/9/2024 | 09/09/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/09/2024
provide install instruction for damper inspection at time of inspection.
not ready
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/9/2024 | 9/9/2024 | 09/09/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/09/2024
date of inspection 8/6/2024
1.drywall approved at concrete walls in stairwells
|
||||
Energy (Insulation) Inspection | Not Ready | 9/9/2024 | 9/9/2024 | 09/09/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/09/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Other/Miscellaneous
Carried Forward
09/09/2024
date of inspection 8/6/2024
1. rock wool at 4th floor ceiling in rated mech shaft approved
|
||||
Other/Miscellaneous
Carried Forward
09/09/2024
1. fire stop at plumbing in parking garage area approved
|
||||
Frame Inspection | Not Ready | 9/10/2024 | 9/10/2024 | 09/10/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/10/2024
date of inspection 8/28/2024
1.stack 39 floor 3 and 4 complete header install at new opening to existing corridor per detail
2.complete fire stopping
3. ok to insulate
GARAGE AREA
1. rockwool at pipe penetration's approved
2.provide documentation to support repair of holes with no pipe in them
|
||||
Other/Miscellaneous
Carried Forward
09/10/2024
date of inspection 8/30/2024
1.stack 39 header at corridor 2nd 3rd 4th floors approved
2. stack 39 2nd level corridor ok to cover ceiling only
|
||||
Other/Miscellaneous
Carried Forward
09/10/2024
date of inspection 9/10/2024
1. cancelled on site by contractor
|
||||
Wallboard / Drywall Inspection | Not Ready | 9/10/2024 | 9/10/2024 | 09/10/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/10/2024
date of inspection 9/10/2024
1. cancelled on site by contractor
|
||||
Energy (Insulation) Inspection | Not Ready | 9/10/2024 | 9/10/2024 | 09/10/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/10/2024
date of inspection 9/10/2024
1. cancelled on site by contractor
|
||||
Fire Or Smoke Damper Inspection | Not Ready | 9/11/2024 | 9/11/2024 | 09/11/2024 |
David Drake ((253) 864-4171) | ||||
Frame Inspection | Not Ready | 9/11/2024 | 9/11/2024 | 09/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/11/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
NO ONE ON SITE AT TIME OF INSPECTION 11:15 AM
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 8/29/2024
1.complete header framing per detail at stack 39 corridor on 2nd 3rd 4th floors
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 9/11/2024
1.cancelled on site by contractor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/11/2024 | 9/11/2024 | 09/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 8/8/2024
1.1 sheet of drywall at stair stringers at bottom of stairs first layer approved
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 9/11/2024
level 2
1. stack 39 corridor west wall 2nd layer and ceiling 2nd layer approved
2. stack 39 corridor east wall approved
|
||||
Energy (Insulation) Inspection | Not Ready | 9/11/2024 | 9/11/2024 | 09/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 9/6/202024
1.no energy was approved
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 9/11/2024
1. cancelled on site by contractor
|
||||
Energy (Insulation) Inspection | Not Ready | 9/11/2024 | 9/11/2024 | 09/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 8/6/2024
1. rock wool at 4th floor ceiling in rated mech shaft approved
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
1. fire stop at plumbing in parking garage area approved
|
||||
Other/Miscellaneous
Carried Forward
09/11/2024
date of inspection 9/11/2024
1. cancelled on site by contractor
|
||||
Gas Test Inspection | Failed | 9/12/2024 | 9/12/2024 | 09/12/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/12/2024
date of inspection 9/12/2024
1. provide test on gas pipe as discussed with contractor (60 PSI)
|
||||
Frame Inspection | Partial Pass | 9/13/2024 | 9/13/2024 | 09/13/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
09/13/2024
date of inspection 8/29/2024
existing building meeting room
1.complete framing
2. complete fire stop
3. complete electrical R/I and provide electrical cover approval at time of next inspection
4. not a complete list
|
||||
Other/Miscellaneous
Outstanding
09/13/2024
insp for rm 108 and corridor header 136
1:firestop top of shafts
2:complete anchor bolts
ok to insulate walls
|
||||
Mechanical Rough In Inspection | Not Ready | 9/13/2024 | 9/13/2024 | 09/13/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
09/13/2024
provide install instruction for damper inspection at time of inspection.
not ready
|
||||
Other/Miscellaneous
Carried Forward
09/13/2024
was not able to load inspection in the am
|
||||
Energy (Insulation) Inspection | Not Ready | 9/13/2024 | 9/13/2024 | 09/13/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
09/13/2024
date of inspection 9/10/2024
1. cancelled on site by contractor
|
||||
Energy (Insulation) Inspection | Not Ready | 9/16/2024 | 9/16/2024 | 09/16/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/16/2024
date of inspection 6/15/2024
1.stairwell insulation approved
2. all framing corrections in stairwell approved including engineering for attic access
LEVEL 2
1.R/C channel in corridor and all units approved
2. insulation at bathroom ceilings and walls approved
|
||||
Other/Miscellaneous
Resolved
09/16/2024
date of inspection 8/6/2024
1. rock wool at 4th floor ceiling in rated mech shaft approved
|
||||
Other/Miscellaneous
Resolved
09/16/2024
1. fire stop at plumbing in parking garage area approved
|
||||
Other/Miscellaneous
Resolved
09/16/2024
date of inspection 9/11/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Carried Forward
09/16/2024
1 ; provide correct sleeves for 2 hour rated ceiling at stack 39 as discussed with contractor.
|
||||
Energy (Insulation) Inspection | Failed | 9/16/2024 | 9/16/2024 | 09/16/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
09/11/2024
date of inspection 9/6/202024
1.no energy was approved
|
||||
Other/Miscellaneous
Outstanding
09/11/2024
date of inspection 9/11/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Outstanding
09/16/2024
1 ; complete insulation in meeting room.
2 ; complete steel plates and rated collars as per install instructions at ceiling of parking garage.
|
||||
Energy (Insulation) Inspection | Failed with Fee | 9/18/2024 | 9/18/2024 | 09/18/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/18/2024
date of inspection 9/10/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Carried Forward
09/18/2024
1 ;pay $180 reinspection fee for correction of item #2 of inspection dated 9/16/2024 not corrected prior to reinspection.
2 ; complete steel plates and rated collars as per install instructions at ceiling of parking garage.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/19/2024 | 9/19/2024 | 09/19/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/19/2024
1. complete fastening of drywall as discussed with contractor
|
||||
Other/Miscellaneous
Carried Forward
09/19/2024
date of inspection 9/6/2024
1. 2nd floor stack 39 west wall of corridor and ceiling complete nailing of drywall as discussed with contractor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/20/2024 | 9/20/2024 | 09/20/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
09/20/2024
date of inspection 9/6/2024
1.level 4 stack 39 corridor ceiling 2nd layer approved
2. level 4 stack 39 corridor west wall 2nd layer stagger was started off sets looked ok
|
||||
Other/Miscellaneous
Carried Forward
09/20/2024
1:1st layer on meeting room lid ok to cover
2:joint lap will be ok on corridor side of meeting room, ok to complete 1st layer,
|
||||
Mechanical Rough In Inspection | Partial Pass | 9/20/2024 | 9/20/2024 | 09/20/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Resolved
09/20/2024
provide install instruction for damper inspection at time of inspection.
not ready
|
||||
Other/Miscellaneous
Resolved
09/20/2024
was not able to load inspection in the am
|
||||
Other/Miscellaneous
Carried Forward
09/20/2024
1:damper from meeting room to existing corridor ok
|
||||
Firewall/Firestop Inspection | Partial Pass | 9/23/2024 | 9/23/2024 | 09/23/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/23/2024
1 ; complete firestop at condensate line at parking garage rated ceiling as discussed with contractor.
2 ; (ok to cover except area noted)
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/23/2024 | 9/23/2024 | 09/23/2024 |
Shannon King ((253) 840-6684) | ||||
Ceiling Grid/T-Bar Inspection | Not Ready | 9/24/2024 | 9/24/2024 | 09/24/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Failed | 9/24/2024 | 9/24/2024 | 09/24/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/24/2024
1 ; complete insulation at stack 39 as discussed with contractor.
|
||||
Energy (Insulation) Inspection | Partial Pass | 9/24/2024 | 9/24/2024 | 09/24/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
09/16/2024
1 ; provide correct sleeves for 2 hour rated ceiling at stack 39 as discussed with contractor.
|
||||
Ceiling Grid/T-Bar Inspection | Failed | 9/25/2024 | 9/25/2024 | 09/25/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
09/25/2024
1 ; complete install of lights and electrical cover approval prior to ceiling grid inspection at floor 2-4 as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Carried Forward
09/25/2024
1 ; complete tie wires at lights as discussed with contractor.
2 ; complete sprinklers as discussed with contractor prior to next inspection.
3 ; complete fire rated signage at fire walls above suspended ceiling.
4 ; complete perimeter wires as discussed with contractor.
5 ; complete fire caulk at penetrations still not completed at time of inspection.
6 ; complete gas pipe test approval prior to ceiling cover approval.
7 ; inspection of corridors ceilings at 3rd &4th floors only. (except last 4' next to expansion joint & stack 39)
|
||||
Wallboard / Drywall Inspection | Failed | 9/25/2024 | 9/25/2024 | 09/25/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/25/2024
date of inspection 8/8/2024
1.1 sheet of drywall at stair stringers at bottom of stairs first layer approved
|
||||
Other/Miscellaneous
Resolved
09/25/2024
date of inspection 9/11/2024
level 2
1. stack 39 corridor west wall 2nd layer and ceiling 2nd layer approved
2. stack 39 corridor east wall approved
|
||||
Other/Miscellaneous
Carried Forward
09/25/2024
complete fire damper opening as per install instructions at all floors as discussed with contractor.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/25/2024 | 9/25/2024 | 09/25/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/25/2024
date of inspection 9/10/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Outstanding
09/25/2024
1 ; 1st layer in corridor next to meeting room.
2 ; 2nd layer of ceiling in meeting room.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/26/2024 | 9/26/2024 | 09/26/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/26/2024
date of inspection 9/6/2024
1. 2nd floor stack 39 west wall of corridor and ceiling complete nailing of drywall as discussed with contractor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 9/27/2024 | 9/27/2024 | 09/27/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
09/27/2024
date of inspection 9/6/2024
1.level 4 stack 39 corridor ceiling 2nd layer approved
2. level 4 stack 39 corridor west wall 2nd layer stagger was started off sets looked ok
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/1/2024 | 10/1/2024 | 10/01/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
10/01/2024
complete fire damper opening as per install instructions at all floors as discussed with contractor.
|
||||
Ceiling Grid/T-Bar Inspection | Partial Pass | 10/1/2024 | 10/1/2024 | 10/01/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 10/1/2024 | 10/1/2024 | 10/01/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 10/1/2024 | 10/1/2024 | 10/01/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
10/01/2024
1 ;pay $180 reinspection fee for correction of item #2 of inspection dated 9/16/2024 not corrected prior to reinspection.
2 ; complete steel plates and rated collars as per install instructions at ceiling of parking garage.
|
||||
Mechanical Rough In Inspection | Partial Pass | 10/2/2024 | 10/2/2024 | 10/02/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 10/3/2024 | 10/3/2024 | 10/03/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
10/03/2024
1 ; complete insulation at stack 39 as discussed with contractor.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/3/2024 | 10/3/2024 | 10/03/2024 |
Shannon King ((253) 840-6684) | ||||
Ceiling Grid/T-Bar Inspection | Partial Pass | 10/7/2024 | 10/7/2024 | 10/07/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
10/07/2024
1 ; complete install of lights and electrical cover approval prior to ceiling grid inspection at floor 2-4 as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Resolved
10/07/2024
1 ; complete tie wires at lights as discussed with contractor.
2 ; complete sprinklers as discussed with contractor prior to next inspection.
3 ; complete fire rated signage at fire walls above suspended ceiling.
4 ; complete perimeter wires as discussed with contractor.
5 ; complete fire caulk at penetrations still not completed at time of inspection.
6 ; complete gas pipe test approval prior to ceiling cover approval.
7 ; inspection of corridors ceilings at 3rd &4th floors only. (except last 4' next to expansion joint & stack 39)
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/7/2024 | 10/7/2024 | 10/07/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Not Ready | 10/8/2024 | 10/8/2024 | 10/08/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Failed | 10/10/2024 | 10/10/2024 | 10/10/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
10/10/2024
1 ; complete fire tape and fire caulk at mechanical shaft.
|
||||
Energy (Insulation) Inspection | Partial Pass | 10/10/2024 | 10/10/2024 | 10/10/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Not Ready | 10/11/2024 | 10/11/2024 | 10/11/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
10/11/2024
1 ; complete drywall at mechanical shaft as per plans.
not ready at time of inspection
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/12/2024 | 10/12/2024 | |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 10/14/2024 | 10/14/2024 | 10/14/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 10/14/2024 | 10/14/2024 | 10/14/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Not Ready | 10/14/2024 | 10/14/2024 | 10/14/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
10/14/2024
1 ;pay $180 reinspection fee for correction of item #2 of inspection dated 9/16/2024 not corrected prior to reinspection.
2 ; complete steel plates and rated collars as per install instructions at ceiling of parking garage.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/15/2024 | 10/15/2024 | 10/15/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Not Ready | 10/16/2024 | 10/16/2024 | 10/16/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
10/16/2024
1 ; complete insulation at stack 39 as discussed with contractor.
|
||||
Energy (Insulation) Inspection | Partial Pass | 10/18/2024 | 10/18/2024 | 10/18/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
10/18/2024
insulation in lids on 4 and 5 level stack 39 mostly in place but not approved for cover until collar deficiency approved at thru corridor and at lid by rc
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/28/2024 | 10/28/2024 | 10/29/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
10/10/2024
1 ; complete fire tape and fire caulk at mechanical shaft.
|
||||
Other/Miscellaneous
Outstanding
10/29/2024
stack 39
1:remove second layer due to laps not working , 1st layer ok with 1 piece of second layer installed to check joints.
|
||||
Wallboard / Drywall Inspection | Not Ready | 10/29/2024 | 10/29/2024 | 10/29/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
10/11/2024
1 ; complete drywall at mechanical shaft as per plans.
not ready at time of inspection
|
||||
Other/Miscellaneous
Outstanding
10/29/2024
not ready did not follow directions from day before
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/30/2024 | 10/30/2024 | 10/30/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
10/30/2024
level 3 and 4 39 stack lid first layer ok
level 2 second layer ok 39 stack
|
||||
Wallboard / Drywall Inspection | Partial Pass | 10/31/2024 | 10/31/2024 | 10/31/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
10/31/2024
stack 39 level 3 and 4 2nd layer on lids ok
|
||||
Energy (Insulation) Inspection | Not Ready | 11/8/2024 | 11/8/2024 | 11/08/2024 |
Shannon King ((253) 840-6684) | ||||
Foundation/Rebar Inspection | Not Ready | 11/13/2024 | 11/13/2024 | 11/13/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
11/13/2024
called in in error
|
||||
Energy (Insulation) Inspection | Failed | 11/13/2024 | 11/13/2024 | 11/13/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
11/13/2024
1 ; provide install instructions for fire collar at time of inspection.
|
||||
Other/Miscellaneous
Carried Forward
11/13/2024
|
||||
Wallboard / Drywall Inspection | Failed | 11/14/2024 | 11/14/2024 | 11/14/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
11/14/2024
complete drywall at expansion joint prior to next inspection.
|
||||
Firewall/Firestop Inspection | Not Ready | 11/14/2024 | 11/14/2024 | 11/14/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
11/14/2024
1 ; complete firestop at condensate line at parking garage rated ceiling as discussed with contractor.
2 ; (ok to cover except area noted)
|
||||
Other/Miscellaneous
Carried Forward
11/14/2024
1 ; complete install of fire collars in stack 39 as per install instructions.
|
||||
Wallboard / Drywall Inspection | Partial Pass | 11/15/2024 | 11/15/2024 | 11/15/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
11/15/2024
1:expansion joint areas rocked and taped.
|
||||
Ceiling Grid/T-Bar Inspection | Failed | 11/18/2024 | 11/18/2024 | 11/18/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
11/18/2024
1 ; complete all ceiling grid,fire taping, firestopping,stencils of fire rated walls,special inspection report for install of fire collars,and mechanical rough-in in break room as discussed with contractor. not ready
|
||||
Comment Building Div Inspection | Not Ready | 11/19/2024 | 11/19/2024 | 11/19/2024 |
Ray Cockerham ((253) 841-5585) | ||||
Other/Miscellaneous
Carried Forward
11/19/2024
General notes:
This record is noted as a "not ready" status only to provide future reference.
G1) Shannon King and Ray Cockerham Met Bill, Rhonda, Spencer and Victor on site for a courtesy walk through we spent just about 2 hours on site.
Most of the item of concern had been addressed with question and answers between Shannon and Spencer; based on previous inspections.
We talked about seeking approval for final from other departments and agencies; L&I electrical, Engineering, Planning, Fire Prevention; in advance of the building final.
Specifically, we talked about following up with Jamie and Micheal regarding engineering questions.
G2) The walk through today was done to provide assistance and should not be considered a complete inspection as many elements were not ready for inspection.
G3) Please let field inspectors know if you have any questions.
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
Accessibility:
A1) Accessible parking stalls require adjustment for slope and cross slope to meet maximum national code standards.
A2) Accessible rooms need to be screen for code compliance by the contractor. Including, reach range for the toilets, grab bars, installation, etc. related to minimum/maximum dimensions.
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
Fire walls/stops and doors.
F1) Fire Walls - Various and many locations require completion of the fire walls, at wall bases (fire caulk and wall repair), penetrations, expansion joints, etc.
During the walk we provided many examples and areas, in rooms, above ceilings and unfinished areas.
F2) Doors; Complete stairwell and service doors; hardware, frames, installation, smoke seals, closures, thresholds, etc.
F3) Stack 39;
F3a)see framing inspection with the date 11/19/2024; install and maintain temporary smoke and fire separation from the occupied space.
F3b) expansion joints need completion prior to cover, 4th floor and others.
F4) Meeting Room - new rated ceiling in the meeting room need completion of fire tape and filling an opening.
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
Exterior
E1) Heat pumps; Review clearance and provide installation instructions for equipment installation close to the fencing. Clearance for air circulation and for service access is required as needed.
E2) Exterior wall: some areas of wall require completion of the exterior surface. noted areas were expansion joint near the parking level under the overhang near the electrical panel, and at grade near the door. Please review for others.
E3) Retaining Wall: at the top of the new retaining wall a concrete trough was constructed to control drainage; please clean this drainage trough of debris and inspect.
E4) Parking, Wheel stops were discussed. Subject to Civil engineer review, some curbs are low.
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
Exit Lighting
L1) Test - after electrical approval, testing and installation is complete of new and relocated devices; please coordinate a test of the exit lighting system.
L2) Low level exit signage was not installed
L3) Relocation of existing exit signage/lighting is needed to provide code needed direction at the new corridor.
|
||||
Frame Inspection | VOID | 11/19/2024 | 11/19/2024 | 11/19/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
11/19/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
NO ONE ON SITE AT TIME OF INSPECTION 11:15 AM
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
date of inspection 8/29/2024
1.complete header framing per detail at stack 39 corridor on 2nd 3rd 4th floors
|
||||
Other/Miscellaneous
Carried Forward
11/19/2024
date of inspection 9/11/2024
1.cancelled on site by contractor
|
||||
Not Ready
Carried Forward
11/19/2024
Fire Sprinkler system is not active in the addition, this creates a fire risk that the contractor needs to address.
Contractor to immediately provide minimum of 2 layers of 5/8 type X fire rated GWB at all hallway connections.
These panels be removable but must be maintained closed and open only as needed for passage.
|
||||
Firewall/Firestop Inspection | Partial Pass | 11/20/2024 | 11/20/2024 | 11/20/2024 |
Shannon King ((253) 840-6684) | ||||
Ceiling Grid/T-Bar Inspection | Partial Pass | 11/20/2024 | 11/20/2024 | 11/20/2024 |
Shannon King ((253) 840-6684) | ||||
Plumbing Final Inspection | Not Ready | 11/26/2024 | 11/26/2024 | 11/26/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
11/26/2024
1. plumbing under slab approved as marked on city approved plans page p 2.0
|
||||
Plumbing Final Inspection | Not Ready | 12/2/2024 | 12/2/2024 | 12/02/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
12/02/2024
1. plumbing under slab approved as marked on city approved plans page p 2.0
|
||||
Wallboard / Drywall Inspection | Failed | 12/9/2024 | 12/9/2024 | 12/09/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
12/09/2024
1 ; will need to inspect drywall nailing of 1st layer at 2nd floor of 2 hour room of stack 39.
( contractor covered both layer without inspection approval)
|
||||
Wallboard / Drywall Inspection | Partial Pass | 12/11/2024 | 12/11/2024 | 12/11/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 12/11/2024 | 12/11/2024 | 12/11/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
12/11/2024
stack 39 level 3 and 4 2nd layer on lids ok
|
||||
Hydrostatic Test 200Lbs 2Hrs | VOID | 12/18/2024 | ||
David Drake ((253) 864-4171) | ||||
Fire Final Inspection | Not Ready | 12/17/2024 | 12/17/2024 | 12/19/2024 |
David Drake ((253) 864-4171) | ||||
Close All Restoration Complete Inspection | VOID | 12/19/2024 | ||
Michael Rosenau ((253) 344-6753) | ||||
Engineering Daily Inspection | VOID | 12/19/2024 | ||
Michael Rosenau ((253) 344-6753) | ||||
Wallboard / Drywall Inspection | Partial Pass | 1/10/2025 | 1/10/2025 | 01/10/2025 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
01/10/2025
1:super to take pic of 8" rip of drywall 2nd layer, pic allowed due to extreme work load.
|
||||
Comment Building Div Inspection | Not Ready | 1/29/2025 | 1/29/2025 | 01/29/2025 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
07/02/2024
cancelled by contractor
|
||||
Underfloor Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Block Wall Rebar Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Refrigeration Line Test Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Block Wall Rebar Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Foundation/Rebar Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Roof Sheathing Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Exhaust/Vent Fans Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Frame Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
09/13/2024
date of inspection 8/29/2024
existing building meeting room
1.complete framing
2. complete fire stop
3. complete electrical R/I and provide electrical cover approval at time of next inspection
4. not a complete list
|
||||
Firewall/Firestop Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Mechanical Rough In Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Mechanical Rough In Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Mechanical Rough In Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Foundation/Rebar Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
11/13/2024
1 ; provide install instructions for fire collar at time of inspection.
|
||||
Other/Miscellaneous
Outstanding
11/13/2024
|
||||
Wallboard / Drywall Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
11/14/2024
complete drywall at expansion joint prior to next inspection.
|
||||
Firewall/Firestop Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
11/14/2024
1 ; complete install of fire collars in stack 39 as per install instructions.
|
||||
Wallboard / Drywall Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Frame Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
11/19/2024
1 ; complete framing as per engineering detail for framing at mechanical shafts at floor 2nd,3rd ,4th, as discussed with contractor.
not ready
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
NO ONE ON SITE AT TIME OF INSPECTION 11:15 AM
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
date of inspection 8/29/2024
1.complete header framing per detail at stack 39 corridor on 2nd 3rd 4th floors
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
date of inspection 9/11/2024
1.cancelled on site by contractor
|
||||
Not Ready
Outstanding
11/19/2024
Fire Sprinkler system is not active in the addition, this creates a fire risk that the contractor needs to address.
Contractor to immediately provide minimum of 2 layers of 5/8 type X fire rated GWB at all hallway connections.
These panels be removable but must be maintained closed and open only as needed for passage.
|
||||
Firewall/Firestop Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Ceiling Grid/T-Bar Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Comment Building Div Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | VOID | 01/30/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
12/09/2024
1 ; will need to inspect drywall nailing of 1st layer at 2nd floor of 2 hour room of stack 39.
( contractor covered both layer without inspection approval)
|
||||
Building Final Inspection | Failed | 1/30/2025 | 1/30/2025 | 01/30/2025 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
01/30/2025
1; no permanent label installed at fire rated doors at 2nd and 3rd floor stair wells doors.
2 ; no lower exit signs install at bottom of stairwell and corridor to parking garage.
|
||||
Footing/Setback Inspection | VOID | 01/31/2025 | ||
Shannon King ((253) 840-6684) | ||||
Comment Building Div Inspection | VOID | 01/31/2025 | ||
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
11/19/2024
General notes :
This record is noted as a "not ready" status only to provide future reference.
G1) Shannon King and Ray Cockerham Met Bill, Rhonda, Spencer and Victor on site for a courtesy walk through we spent just about 2 hours on site.
Most of the item of concern had been addressed with question and answers between Shannon and Spencer; based on previous inspections.
We talked about seeking approval for final from other departments and agencies; L&I electrical, Engineering, Planning, Fire Prevention; in advance of the building final.
Specifically, we talked about following up with Jamie and Micheal regarding engineering questions.
G2) The walk through today was done to provide assistance and should not be considered a complete inspection as many elements were not ready for inspection.
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
Accessibility:
A1) Accessible parking stalls require adjustment for slope and cross slope to meet maximum national code standards.
A2) Accessible rooms need to be screen for code compliance by the contractor. Including, reach range for the toilets, grab bars, installation, etc. related to minimum/maximum dimensions.
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
Fire walls/stops and doors.
F1) Fire Walls - Various and many locations require completion of the fire walls, at wall bases (fire caulk and wall repair), penetrations, expansion joints, etc.
During the walk we provided many examples and areas, in rooms, above ceilings and unfinished areas.
F2) Doors; Complete stairwell and service doors; hardware, frames, installation, smoke seals, closures, thresholds, etc.
F3) Stack 39;
F3a)see framing inspection with the date 11/19/2024; install and maintain temporary smoke and fire separation from the occupied space.
F3b) expansion joints need completion prior to cover, 4th floor and others.
F4) Meeting Room - new rated ceiling in the meeting room need completion of fire tape and filling an opening.
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
Exterior
E1) Heat pumps; Review clearance and provide installation instructions for equipment installation close to the fencing. Clearance for air circulation and for service access is required as needed.
E2) Exterior wall: some areas of wall require completion of the exterior surface. noted areas were expansion joint near the parking level under the overhang near the electrical panel, and at grade near the door. Please review for others.
E3) Retaining Wall: at the top of the new retaining wall a concrete trough was constructed to control drainage; please clean this drainage trough of debris and inspect.
E4) Parking, Wheel stops were discussed. Subject to Civil engineer review, some curbs are low.
|
||||
Other/Miscellaneous
Outstanding
11/19/2024
Exit Lighting
L1) Test - after electrical approval, testing and installation is complete of new and relocated devices; please coordinate a test of the exit lighting system.
L2) Low level exit signage was not installed
L3) Relocation of existing exit signage/lighting is needed to provide code needed direction at the new corridor.
|
Condition | Status | Department | Category | Expiration Date | Due Date |
---|---|---|---|---|---|
Building Permit Standard Conditions | Open | Development & Permitting Services | Standard Conditions | ||
:
* Final approval by the Building Official is required prior to use or occupancy.* Work shall not proceed until the inspector has approved the stages of construction.* Surface storm water shall be diverted from the building site and shall not drain onto adjacent properties.* I hereby acknowledge that I have read this Permit/Application, that the information given is correct; that I am the owner or the duly authorized agent of the owner; that plans submitted herewith are in compliance with all applicable city, county and state laws and that all construction will proceed in accordance with said laws. This permit shall expire if work is not commenced with 180 days or if the work is suspended for a period of 180 days. Permits expire two years from issuance. * By leaving the contractor information section blank, I hereby certify further that contractors (general or subcontractors) will not be hired to perform any work in association with this permit. I also certify that if I do choose to hire a contractor (general or subcontractor) I will only hire those contractors that are licensed by the State of Washington. If you are a property owner, contractor or permittee and you are paying for someone to perform the work, they must have a valid contractor registration and the person(s) installing plumbing inside a structure must meet the plumbing certification requirements. If you have any questions regarding these regulations, you may contact the Washington State Department of Labor and Industries or you can find more information on-line at: http://www.lni.wa.gov/TradesLicensing/Contractors/HireCon/default.asp
|
|||||
Engineering Commercial Standard Conditions | Open | Development & Permitting Services | Standard Conditions | ||
:
** Prior to STARTING the applicant shall request an erosion and sediment control inspection using the CityView permit portal at least 48 hours in advance of job start **
* Prior to STARTING site work; request inspection for Erosion and Sediment - also see approved civil plans E-20-0052 **
** See drawing submitted by applicant in CityView 08/09/2022 named CTE 22012 2022 0322 PERMIT ISSUE Shoring Hampton Inn Addition - MARK UP for approved water, domestic and fire, locations **
** OCCUPANCY WILL NOT BE GRANTED UNTIL ALL CIVIL WORK ASSOCIATED WITH E-20-0052 IS COMPLETED AND APPROVAL HAS BEEN PROVIDED **
* THE APPLICANT IS RESPONSIBLE TO SCHEDULE INSPECTIONS. UTILITY INSPECTIONS ARE REQUIRED PRIOR TO BACKFILLING.
** STORMWATER CONTROL OF ROOF DOWNSPOUTS MUST BE CONTROLLED also see approved civil plans E-20-0052 *
** SEDIMENT CONTROL AND EROSION PROCEDURES SHALL BE PRACTICE TO ELIMINATE AND PREVENT OFF SITE DAMAGE. STORMWATER RUNOFF ORIGINATING UPGRADE OF EXPOSED AREAS SHALL BE CONTROLLED TO REDUCE EROSION AND SEDIMENT LOSS DURING THE PERIOD OF EXPOSURE.
* Curb, gutter, sidewalk and approach must be poured per City Standards.
* Driveway approach must be a minimum of 30' wide.
* The builder/owner shall be responsible for keeping the existing right-of-way free of debris and dirt. Any violation of PMC Chapter 21.14 pertaining to clearing, filling and grading, erosion and sediment control, and storm water discharges shall be prosecuted to the fullest extent of the law.
* Any addition/expansion to the foot print of the building including decks and porches not originally shown on the approved set of plans must obtain proper permits prior to construction.
* The applicant is responsible to call the Utility Notification Center at 1-800-424-5555 before beginning any excavation. Call before you dig, it's the law.
* No work shall be done in or on the public right of way without a licensed and bonded contractor first obtaining a right of way permit.
* Any code requirement that may have been overlooked in this plan review does not imply that the requirements have been waived.
* All commercial development water service connections are to be protected by a reduced pressure backflow assembly (RPBA), as directed by the Puyallup Municipal Code 14.02.220(3) and conforming to City Standard Section 3.2.2 and Details 03.04.02-1, 03.04.02-2 and 03.04.03.
* All commercial developments, irrigation systems and multi family water service connections shall be protected by at reduced pressure backflow assembly (RPBA), as directed by the City, Fruitland Mutual Water Company, Tacoma City Water or Valley Water District conforming to City Standard Details 03.04.02-1, 03.04.02-2 and 03.04.03.
Effective January 1, 2013 RCW 19.122 Before conducting any construction or excavation within 100 feet of a right of way or utility easement containing a transmission pipeline a person must notify the pipeline companies of the scheduled excavation through the one number locator service 811. Notification must occur in a window of not less than 2 business days but not more than 10 business days before beginning the excavation. If a transmission pipeline company is notified that excavation work will occur near a pipeline, a representative of the company must consult with the excavator on site prior to excavation.
|
|||||
Pipeline Notfication Rcw 19.122.033 | Open | Engineering Division | Standard Conditions | ||
:
Effective January 1, 2013 RCW 19.122 Before conducting any construction or excavation within 100 feet of a right-of-way or utility easement containing a transmission pipeline a person must notify the pipeline companies of the scheduled excavation through the one-number locator service 811. Notification must occur in a window of not less than 2 business days but not more than 10 business days before beginning the excavation. If a transmission pipeline company is notified that excavation work will occur near a pipeline, a representative of the company must consult with the excavator on-site prior to excavation.
|
|||||
Miscellaneous Condition | Resolved | Engineering Division | Prior to Occupancy | ||
:
** Occupancy will not be granted until all associated work with civil permit E-20-0052 is completed and approved **
** STORMWATER CONTROL OF ROOF DOWNSPOUTS MUST BE CONTROLLED. ATTACHED TO THE SITE PLAN IS A TYPICAL INFILTRATION SYSTEM YOU MAY CHOOSE TO FOLLOW. FOR ANY QUESTIONS CALL MARCUS SEDLICKAS, ENGINEERING INSPECTOR, AT 253-405-1707
** SEDIMENT CONTROL AND EROSION PROCEDURES SHALL BE PRACTICE TO ELIMINATE AND PREVENT OFF SITE DAMAGE. STORMWATER RUNOFF ORIGINATING UPGRADE OF EXPOSED AREAS SHALL BE CONTROLLED TO REDUCE EROSION AND SEDIMENT LOSS DURING THE PERIOD OF EXPOSURE.
* The builder/owner shall be responsible for keeping the existing right-of-way free of debris and dirt. Any violation of PMC Chapter 21.14 pertaining to clearing, filling and grading, erosion and sediment control, and storm water discharges shall be prosecuted to the fullest extent of the law.
* Any addition/expansion to the foot print of the building including decks and porches not originally shown on the approved set of plans must obtain proper permits prior to construction.
* The applicant is responsible to call the Utility Notification Center at 1-800-424-5555 before beginning any excavation. Call before you dig, it's the law.
* No work shall be done in or on the public right of way without a licensed and bonded contractor first obtaining a right of way permit.
* Any code requirement that may have been overlooked in this plan review does not imply that the requirements have been waived.
* All commercial development water service connections are to be protected by a reduced pressure backflow assembly (RPBA), as directed by the Puyallup Municipal Code 14.02.220(3) and conforming to City Standard Section 3.2.2 and Details 03.04.02-1, 03.04.02-2 and 03.04.03.
|
|||||
Miscellaneous Condition | Resolved | Development & Permitting Services | Prior to Issuance | ||
:
Civil permit E-20-0052 has been issued
|
|||||
Miscellaneous Condition | Resolved | Development & Permitting Services | Prior to Occupancy | ||
:
PERMIT RENEWAL FEE OF $6,793.82 MUST BE PAID PRIOR TO OCCUPANCY/FINAL INSPECTION
VICTOR MADE PAYMENT TODAY 5/7/2024. RESOLVED CONDITION SO THEY CAN CARRY ON. [Julie Johnson @ 05/07/2024 2:33 PM]
|
Reference Number | Status | Type |
---|---|---|
E-20-0052 | Permit(s) Issued | Civil Construction Permit |
PRGR20230876 | Closed | Clear, Fill, & Grade Permit |
PRFS20231302 | Closed | Fire Sprinklers |
PRRWF20240597 | Closed | Retaining Wall |
PRFA20240971 | Closed | Fire Alarms |
PRFA20241511 | Closed | Fire Alarms |
Should you need assistance, please contact the Permit Center at (253) 864-4165 option 1.
Powered by CityView
