CITY OF PUYALLUP PERMITTING PORTAL
Permit Application Status
B-20-0180
In order to request inspections, you need to be signed in.
Paid Fees | Amount | Paid | Owing | Date Paid |
---|---|---|---|---|
Planning Building Permit Fee (Not payable online) | $120.00 | $120.00 | Paid | 11/16/2021 |
No
|
||||
WA State Building Code Council Fee (Residential) (Not payable online) | $239.00 | $239.00 | Paid | 11/16/2021 |
No
|
||||
Sanitary Sewer Connection Fee (Not payable online) | $466.00 | $466.00 | Paid | 11/16/2021 |
No
|
||||
Building Division Fee (Hourly) (Not payable online) | $130.03 | $130.03 | Paid | 11/16/2021 |
No
|
||||
Fire Review Fee (Commercial Building) (Not payable online) | $265.00 | $265.00 | Paid | 11/16/2021 |
No
|
||||
Planning Landscape Review Fee (Not payable online) | $300.00 | $300.00 | Paid | 11/16/2021 |
No
|
||||
Mechanical Plan Review Fee (Not payable online) | $2,786.19 | $2,786.19 | Paid | 11/16/2021 |
No
|
||||
Plumbing Plan Review Fee (Not payable online) | $5,405.89 | $5,405.89 | Paid | 11/16/2021 |
No
|
||||
Mechanical Permit Fee (Not payable online) | $4,286.45 | $4,286.45 | Paid | 11/16/2021 |
No
|
||||
Plumbing Permit Fee (Not payable online) | $8,316.75 | $8,316.75 | Paid | 11/16/2021 |
No
|
||||
Building Permit Fee (Not payable online) | $51,233.75 | $51,233.75 | Paid | 11/16/2021 |
No
|
||||
Building Plan Review Fee (Not payable online) | $33,301.94 | $33,301.94 | Paid | 03/17/2020 |
No
|
||||
Resubmittal Fee | $180.00 | $180.00 | Paid | 06/08/2023 |
Outstanding Fees | Amount | Paid | Owing | Date Paid |
Sewer System Development Charge | $479,644.66 | $0.00 | $479,644.66 | Not Paid |
Totals: | $586,675.66 | $107,031.00 | $479,644.66 |
Permit(s) will not be issued until outstanding fees have been paid in full. Fee details shown above only include currently payable fees, there might be addtional fees to be paid before issuance.
$479,644.66 Add Fees to My Cart
Inspection | Outcome | Requested | Scheduled | Date Inspected |
---|---|---|---|---|
Carbon Monoxide Detectors Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Combination Frame And Rough In Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Mechanical Final Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Ceiling Grid/T-Bar Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Emergency Radio Test Review Inspection | Pending | |||
David Drake ((253) 864-4171) | ||||
Building Final Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Footing/Setback Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Plumbing Final Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Exit Lighting Test Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Fire Final Inspection | Pending | |||
David Drake ((253) 864-4171) | ||||
Engineering Final Inspection | Pending | |||
Other/Miscellaneous
Outstanding
08/10/2022
E-21-0542 MUST be completed prior to granting occupancy.
E-20-0070 is the onsite civil.
|
||||
Foundation/Rebar Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
11/21/2023
1. this was interior footing inspection
2.interior footing north end of building ,footing for columns at entry way , and footings for columns in swimming pool area approved to pour as marked up on pages S-201.1A and S-201.1B of city approved plans and special inspections
|
||||
Foundation/Rebar Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
01/04/2024
1.interior footings south end of building and trash footing and columns as marked up on city approved plans pages S-201.1A and S-201.1B
2.approved to pour per special inspections
3.provide special inspection report as discussed with steve
|
||||
Shear Wall Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
03/06/2024
1. cancelled on site by contractor
|
||||
Shear Wall Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Energy (Insulation) Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
06/20/2024
date of inspection 6/20/2024
1. complete insulation of south exterior wall at mech shaft
|
||||
Wallboard / Drywall Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/11/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
LEVEL ONE CORRIDOR DRYWALL
date of inspection 6/20/2024
1. complete areas that were not done at time of inspection
2. it appears that areas where multiple layers of drywall are required it is being covered up with out inspections
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
date of inspection 6/24/2024
1. 1st floor corridor top out approved
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
inspection date 6/26/2024
1.first layer of drywall at shafts stacks 208,210,212,213,214,216, approved as marked up on city approved plans page A-101
2.insulation and vapor barrier at exterior wall at north east mech shaft approved as marked up on sheet A-101 of city approved plans
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
date of inspection 7/1/2024
1.from elevator south second layer at shafts approved
2. from east to west first layer at shafts approved
3. as marked up on city approved plans PG A-101
|
||||
Other/Miscellaneous
Outstanding
07/11/2024
date of inspection 7/9/2024
1. 2nd layer of shafts approved as marked up on city approved plans page A-101
|
||||
Wallboard / Drywall Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/11/2024
date of inspection 7/11/2024
this was a comment inspection
discussed mech shaft designs
|
||||
Comment Building Div Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/18/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Other/Miscellaneous
Outstanding
07/18/2024
date of inspection 6/17/2024
1. discussed shaft designs
|
||||
Other/Miscellaneous
Outstanding
07/18/2024
1. this was mech R/I inspection
2. 4th floor corridor mech partial approval as marked up on city approved plans pages M-204A and M-204B
3.date of inspection 7/10/2024
|
||||
Frame Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Frame Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Energy (Insulation) Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Energy (Insulation) Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Ceiling Grid/T-Bar Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Ceiling Grid/T-Bar Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Firewall/Firestop Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Energy (Insulation) Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Fire Complaint Inspection | Pending | |||
David Drake ((253) 864-4171) | ||||
Fire Inspection Required
Outstanding
07/22/2024
1. Fuel storage needs vehicle impact protection. Provide ecology blocks or bollards to be compliant with 2018 IFC Section 312.
2. Provide spill kit for fuel storage.
3. Provide Fire Extinguisher for fuel storage.
4. Fire Extinguishers throughout building not tagged. Provide proper tags and certification for all onsite Extinguishers.
5. GC was warned not to cover fire sprinkler piping on roof by Building Inspectors Kevin and Shannon prior to this inspection. All areas can not be visually seen and will not be approved or inspected through holes cut in the walls. Remove all areas that cover fire sprinkler piping prior to next inspection.
6. These areas on the roof will require heat detection if not already shown on the Fire Alarm plans. Heat detectors are required to have 24/7 access to each device. Access hatches will be required for each device. Annual inspections on the fire alarm system will be a challenge if not framed correctly.
|
||||
Mechanical Rough In Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/22/2024
1 ; nobody on-site with access to city approved plans at time of inspection. ( 8:00 am,no access to office)
|
||||
Frame Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Firewall/Firestop Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Wallboard / Drywall Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Plumbing Rough In Inspection | Pending | |||
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/25/2024
date of inspection 6/24/2024
1. gas pipe risers from 1st floor to roof approved at 10 psi as noted on page P-310 of city approved plans
2. roof drains approved as marked up on page 309 of city approved plans
FLOOR 5
1. DWV and supply test (supply at 90 psi) approved at rooms 529,527,525,523,524,526,528,530 as marked up on city approved plans page P-21013
FLOOR 4
1. DWV and supply test (supply at 90 psi) approved at rooms 429,427,425,423,424,426,428,430 as marked up on city approved plans page P-208B
|
||||
Other/Miscellaneous
Outstanding
07/25/2024
date of inspection 6/27/2024
1.hot water circ line approved as marked up on page P-307 of city approved plans
2. floors 4 and 5 DWV and supply approved as marked up on city approved plans page P-208
3. rain drains approved as marked up on city approved plans page 309
|
||||
Other/Miscellaneous
Outstanding
07/25/2024
date of inspection 7/2/2024
1.5th floor dwv and supply approved as marked up on P-210B of city approved plans
2. 4th floor dwv and supply approved as marked up on P-208B of city approved plans
3. rain drains approved as marked up on P-309 of city approved plans
|
||||
Frame Inspection | Pending | 7/29/2024 | ||
Monty Johnson ((253) 770-3326) | ||||
Wallboard / Drywall Inspection | Pending | 7/29/2024 | ||
Monty Johnson ((253) 770-3326) | ||||
Mechanical Rough In Inspection | Pending | 7/17/2024 | 7/17/2024 | |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
07/15/2024
1. this was a comment inspection
2. discussed mech requirements
|
||||
Other/Miscellaneous
Outstanding
07/15/2024
date of inspection 7/2/2024
1. 5th floor corridors mech partial approval as marked up on city approved plans pages M-205A and M-205B
2. provide as-built approval from engineer for pipe size changes
|
||||
Other/Miscellaneous
Outstanding
07/15/2024
1.date of inspection 7/15/2024
2.this was a comment inspection
3. discussed attachment of shaft liner at corridor walls at mech shafts
|
||||
Engineering Final Inspection | Not Ready | 8/10/2022 | 08/10/2022 | |
Ray Cockerham ((253) 841-5585) | ||||
Other/Miscellaneous
Carried Forward
08/10/2022
E-21-0542 MUST be completed prior to granting occupancy.
E-20-0070 is the onsite civil.
|
||||
Comment Building Div Inspection | Not Ready | 10/14/2022 | 10/14/2022 | 10/14/2022 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
10/14/2022
talked about geo tech, special inspections and inspection call in's
|
||||
Planning Final Inspection | Not Ready | 10/21/2022 | ||
Chris Beale ((253) 841-5418) | ||||
Planning Final Inspection | VOID | 10/25/2022 | ||
Chris Beale ((253) 841-5418) | ||||
Comment Building Div Inspection | Partial Pass | 4/26/2023 | 4/26/2023 | 04/26/2023 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
04/26/2023
talked about inspections, special inspections , geo tech etc.
|
||||
Comment Building Div Inspection | Partial Pass | 5/16/2023 | 5/16/2023 | 05/16/2023 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
05/16/2023
1: geo piers progressing with special inspection, provide special inspection reports directly to kevin spruel and myself by email.
|
||||
Comment Building Div Inspection | Not Ready | 5/17/2023 | 5/17/2023 | 05/17/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
05/17/2023
1. progression inspection on geo piers machine broke at time of inspection
|
||||
Foundation/Rebar Inspection | Not Ready | 6/28/2023 | 6/28/2023 | 06/28/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/28/2023
1.complete rebar at elevator pit per city approved plans
2. complete rebar at steps in footings per city approved plans
3. provide special inspection approval with revised plans referenced at time of next inspection
4. not ready
|
||||
Foundation/Rebar Inspection | Not Ready | 7/10/2023 | 7/10/2023 | 07/10/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/10/2023
1.complete rebar at elevator pit per city approved plans
2. complete rebar at steps in footings per city approved plans
3. provide special inspection approval with revised plans referenced at time of next inspection
4. not ready
|
||||
Other/Miscellaneous
Carried Forward
07/10/2023
1. complete rebar that is missing at step per city approved plans
2. provide engineer of records report for sleeves that are in footings at time of next inspection
3. do not pour
|
||||
Foundation/Rebar Inspection | Not Ready | 8/2/2023 | 8/2/2023 | 08/02/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/02/2023
1.complete rebar at elevator pit per city approved plans
2. complete rebar at steps in footings per city approved plans
3. provide special inspection approval with revised plans referenced at time of next inspection
4. not ready
|
||||
Other/Miscellaneous
Carried Forward
08/02/2023
1. complete rebar that is missing at step per city approved plans
2. provide engineer of records report for sleeves that are in footings at time of next inspection
3. do not pour
|
||||
Other/Miscellaneous
Carried Forward
08/02/2023
1. cancelled per contractor
|
||||
Foundation/Rebar Inspection | Partial Pass | 8/3/2023 | 8/3/2023 | 08/03/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
08/03/2023
1. this was a footing set back inspection
2.set backs and footing placement where verified by licensed surveyor
3.no interior footings or exterior Colum footing are included in this inspection
4. APPROVED TO POUR EXTERIOR FOOTING per special inspections
|
||||
Foundation/Rebar Inspection | Not Ready | 8/31/2023 | 8/31/2023 | 09/01/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
09/01/2023
1.complete rebar at elevator pit per city approved plans
2. complete rebar at steps in footings per city approved plans
3. provide special inspection approval with revised plans referenced at time of next inspection
4. not ready
|
||||
Other/Miscellaneous
Resolved
09/01/2023
1. complete rebar that is missing at step per city approved plans
2. provide engineer of records report for sleeves that are in footings at time of next inspection
3. do not pour
|
||||
Other/Miscellaneous
Resolved
09/01/2023
1. cancelled per contractor
|
||||
Other/Miscellaneous
Carried Forward
09/01/2023
1.foundation wall inspection for perimeter
2.complete rebar at elevator pit per city approved plans
3.provide detail sheet for sleeve thru wall at time of next inspection
4.provide step clarification from engineer of record at time of next inspection
5.clarify if special inspection is required for water stop
6.provide lap schedule for rebar at time of next inspection
7.provide new special inspections reports to support corrections
|
||||
Foundation/Rebar Inspection | Partial Pass | 9/5/2023 | 9/5/2023 | 09/05/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/05/2023
1. this was a footing set back inspection
2.set backs and footing placement where verified by licensed surveyor
3.no interior footings or exterior Colum footing are included in this inspection
4. APPROVED TO POUR EXTERIOR FOOTING per special inspections
|
||||
Plumbing Rough In Inspection | Partial Pass | 9/20/2023 | 9/20/2023 | 09/20/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/20/2023
1. this was a under slab plumbing inspection
2.rain drain, sump pump at elevator pit approved as marked on page P-202B
3. 4" deep sewer approved as marked up on page P-202A
4. 4" water service on air test at 80 PSI approved as marked up on page P-201B
|
||||
Energy (Insulation) Inspection | Partial Pass | 9/25/2023 | 9/25/2023 | 09/25/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Plumbing Rough In Inspection | Partial Pass | 9/28/2023 | 9/28/2023 | 09/29/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
09/29/2023
1. this was a under slab plumbing inspection
2.rain drain, sump pump at elevator pit approved as marked on page P-202B
3. 4" deep sewer approved as marked up on page P-202A
4. 4" water service on air test at 80 PSI approved as marked up on page P-201B
|
||||
Other/Miscellaneous
Carried Forward
09/29/2023
1. this was under slab plumbing inspection
2. contractor to provide approved as-built of all plumbing changes from engineer of record at time of final under slab plumbing inspection as discussed with contractor
3.partial approval of rain drain as marked on P-202-A of city approved plans
4.partial approval on deep sewer as marked on pages P-202-A and P-202-B of city approved plans
5.partial approval of grease interceptor on interior of building going into sewer as marked on city P-202-A of city approved plans
|
||||
Plumbing Rough In Inspection | Partial Pass | 10/24/2023 | 10/24/2023 | 10/24/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
10/24/2023
1. this was a under slab plumbing inspection
2.rain drain, sump pump at elevator pit approved as marked on page P-202B
3. 4" deep sewer approved as marked up on page P-202A
4. 4" water service on air test at 80 PSI approved as marked up on page P-201B
|
||||
Other/Miscellaneous
Carried Forward
10/24/2023
1. this was under slab plumbing inspection
2. contractor to provide approved as-built of all plumbing changes from engineer of record at time of final under slab plumbing inspection as discussed with contractor
3.partial approval of rain drain as marked on P-202-A of city approved plans
4.partial approval on deep sewer as marked on pages P-202-A and P-202-B of city approved plans
5.partial approval of grease interceptor on interior of building going into sewer as marked on city P-202-A of city approved plans
|
||||
Other/Miscellaneous
Carried Forward
10/24/2023
UNDER SLAB PLUMBING INSPECTION
1.rain drains approved as marked up on city approved plans pages P-202A and P-202B
2.horizontal branch lines under slab as marked up on city approved plans pages P-202A and P-202B
3.plumbing drains that go to greece interceptor tested to inside of foundation approved as marked up on city approved plans pages P-202A and P-202B
4. provide engineers approval of cut top bar in foundation wall as discussed with contractor
5. paint rebar that is exposed where concrete is chipped out for plumbing pipe
|
||||
Foundation/Rebar Inspection | Partial Pass | 11/21/2023 | 11/21/2023 | 11/21/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
11/21/2023
1.foundation wall inspection for perimeter
2.complete rebar at elevator pit per city approved plans
3.provide detail sheet for sleeve thru wall at time of next inspection
4.provide step clarification from engineer of record at time of next inspection
5.clarify if special inspection is required for water stop
6.provide lap schedule for rebar at time of next inspection
7.provide new special inspections reports to support corrections
|
||||
Other/Miscellaneous
Carried Forward
11/21/2023
1. this was interior footing inspection
2.interior footing north end of building ,footing for columns at entry way , and footings for columns in swimming pool area approved to pour as marked up on pages S-201.1A and S-201.1B of city approved plans and special inspections
|
||||
Foundation/Rebar Inspection | Partial Pass | 12/12/2023 | 12/12/2023 | 12/12/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
12/12/2023
1. this was a footing set back inspection
2.set backs and footing placement where verified by licensed surveyor
3.no interior footings or exterior Colum footing are included in this inspection
4. APPROVED TO POUR EXTERIOR FOOTING per special inspections
|
||||
Other/Miscellaneous
Carried Forward
12/12/2023
1.interior footings south end of building and trash footing and columns as marked up on city approved plans pages S-201.1A and S-201.1B
2.approved to pour per special inspections
3.provide special inspection report as discussed with steve
|
||||
Comment Building Div Inspection | Partial Pass | 12/20/2023 | 12/20/2023 | 12/20/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
12/20/2023
1. progression inspection on geo piers machine broke at time of inspection
|
||||
Other/Miscellaneous
Carried Forward
12/20/2023
1. provide letter from engineer of record for cut bar at elevator door buck outs
2.complete bar at south stair well pit and provide special inspection report
3. ok to pour slab south area only excludes south stair well
|
||||
Plumbing Rough In Inspection | Partial Pass | 12/28/2023 | 12/28/2023 | 12/28/2023 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
12/28/2023
1. this was a under slab plumbing inspection
2.rain drain, sump pump at elevator pit approved as marked on page P-202B
3. 4" deep sewer approved as marked up on page P-202A
4. 4" water service on air test at 80 PSI approved as marked up on page P-201B
|
||||
Other/Miscellaneous
Resolved
12/28/2023
1. this was under slab plumbing inspection
2. contractor to provide approved as-built of all plumbing changes from engineer of record at time of final under slab plumbing inspection as discussed with contractor
3.partial approval of rain drain as marked on P-202-A of city approved plans
4.partial approval on deep sewer as marked on pages P-202-A and P-202-B of city approved plans
5.partial approval of grease interceptor on interior of building going into sewer as marked on city P-202-A of city approved plans
|
||||
Other/Miscellaneous
Resolved
12/28/2023
UNDER SLAB PLUMBING INSPECTION
1.rain drains approved as marked up on city approved plans pages P-202A and P-202B
2.horizontal branch lines under slab as marked up on city approved plans pages P-202A and P-202B
3.plumbing drains that go to greece interceptor tested to inside of foundation approved as marked up on city approved plans pages P-202A and P-202B
4. provide engineers approval of cut top bar in foundation wall as discussed with contractor
5. paint rebar that is exposed where concrete is chipped out for plumbing pipe
|
||||
Other/Miscellaneous
Carried Forward
12/28/2023
1.new kitchen area under slab plumbing approved
2. provide as-built of underslab plumbing as discussed with contractor
|
||||
Foundation/Rebar Inspection | Partial Pass | 1/4/2024 | 1/4/2024 | 01/04/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
01/04/2024
1.interior footings south end of building and trash footing and columns as marked up on city approved plans pages S-201.1A and S-201.1B
2.approved to pour per special inspections
3.provide special inspection report as discussed with steve
|
||||
Comment Building Div Inspection | Partial Pass | 1/4/2024 | 1/4/2024 | 01/04/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
01/04/2024
1. provide letter from engineer of record for cut bar at elevator door buck outs
2.complete bar at south stair well pit and provide special inspection report
3. ok to pour slab south area only excludes south stair well
|
||||
Shear Wall Inspection | Not Ready | 3/6/2024 | 3/6/2024 | 03/06/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
03/06/2024
1. cancelled on site by contractor
|
||||
Wallboard / Drywall Inspection | Partial Pass | 3/8/2024 | 3/8/2024 | 03/08/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
03/08/2024
1. provide special inspection approval for shear walls at north and south stairwells 1st floor
2. 1st layer of drywall of interior stair walls north and south stairwell approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 3/26/2024 | 3/26/2024 | 03/26/2024 |
Ray Cockerham ((253) 841-5585) | ||||
Other/Miscellaneous
Carried Forward
03/26/2024
1. provide special inspection approval for shear walls at north and south stairwells 1st floor
2. 1st layer of drywall of interior stair walls north and south stairwell approved
|
||||
Shear Wall Inspection | Partial Pass | 03/26/2024 | ||
Ray Cockerham ((253) 841-5585) | ||||
Wallboard / Drywall Inspection | Partial Pass | 3/29/2024 | 3/29/2024 | 03/29/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
03/29/2024
1. provide special inspection approval for shear walls at north and south stairwells 1st floor
2. 1st layer of drywall of interior stair walls north and south stairwell approved
|
||||
Other/Miscellaneous
Carried Forward
03/29/2024
1:stairwell 1 , 2nd layer on ext side of wells level 2 and 3 ok with all joints taped and mudded.
2: stairwell 2, level 2 and 3 ext side of wells 1st layer ok minus face side, will need reoriented to get 16" laps on joints.
|
||||
Wallboard / Drywall Inspection | Not Ready | 4/2/2024 | 4/2/2024 | 04/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
04/02/2024
1. provide special inspection approval for shear walls at north and south stairwells 1st floor
2. 1st layer of drywall of interior stair walls north and south stairwell approved
|
||||
Other/Miscellaneous
Carried Forward
04/02/2024
1. cancelled on site by contractor
|
||||
Wallboard / Drywall Inspection | Not Ready | 4/15/2024 | 4/15/2024 | 04/15/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
04/15/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Carried Forward
04/15/2024
1. provide clarification from architect on wall ratings on all stair walls
|
||||
Frame Inspection | Not Ready | 4/16/2024 | 4/16/2024 | 04/16/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
04/16/2024
1. this was a comment inspection
2.discussed framing on roof
|
||||
Wallboard / Drywall Inspection | Not Ready | 4/18/2024 | 4/18/2024 | 04/18/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
04/18/2024
1. provide clarification from architect on wall ratings on all stair walls
|
||||
Other/Miscellaneous
Carried Forward
04/18/2024
1. this was a comment inspection
2. discussed UL listing for stair walls
|
||||
Comment Building Div Inspection | Partial Pass | 4/19/2024 | 4/19/2024 | 04/19/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
04/19/2024
1. provide letter from engineer of record for cut bar at elevator door buck outs
2.complete bar at south stair well pit and provide special inspection report
3. ok to pour slab south area only excludes south stair well
|
||||
Other/Miscellaneous
Carried Forward
04/19/2024
THIS WAS DRYWALL INSPECTION
NORTH STAIRWELL
1.level 4 and 5 hotel side south and west wall first layer approved
SOUTH STAIRWELL
1.level 5 hotel side north and east wall first layer approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 4/23/2024 | 4/23/2024 | 04/24/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
04/24/2024
1. provide clarification from architect on wall ratings on all stair walls
|
||||
Other/Miscellaneous
Resolved
04/24/2024
1. this was a comment inspection
2. discussed UL listing for stair walls
|
||||
Other/Miscellaneous
Carried Forward
04/24/2024
1.north stairwell floors 4 and 5 hotel side west and south ok to proceed with 2nd layer
2. south stairwell floor 5 hotel side east wall ok to proceed with 2nd layer
|
||||
Comment Building Div Inspection | Partial Pass | 4/24/2024 | 4/24/2024 | 04/25/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
04/25/2024
THIS WAS DRYWALL INSPECTION
NORTH STAIRWELL
1.level 4 and 5 hotel side south and west wall first layer approved
SOUTH STAIRWELL
1.level 5 hotel side north and east wall first layer approved
|
||||
Other/Miscellaneous
Carried Forward
04/25/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Wallboard / Drywall Inspection | Partial Pass | 4/26/2024 | 4/26/2024 | 04/26/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
04/26/2024
1.north stairwell floors 4 and 5 hotel side west and south ok to proceed with 2nd layer
2. south stairwell floor 5 hotel side east wall ok to proceed with 2nd layer
|
||||
Other/Miscellaneous
Carried Forward
04/26/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Frame Inspection | Failed | 5/2/2024 | 5/2/2024 | 05/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
05/02/2024
1. this was a comment inspection
2.discussed framing on roof
|
||||
Other/Miscellaneous
Carried Forward
05/02/2024
THIS WAS FOR ALL PARAPET FRAMING ON ROOF
1. provide clarification from EOR on plate attachment on walls at interior
2.provide clarification on clips at angle stud to bottom plate on 2 tallest parapets
3. complete all missing hardware as discussed with framer
|
||||
Frame Inspection | Partial Pass | 5/6/2024 | 5/6/2024 | 05/06/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
05/06/2024
THIS WAS FOR ALL PARAPET FRAMING ON ROOF
1. provide clarification from EOR on plate attachment on walls at interior
2.provide clarification on clips at angle stud to bottom plate on 2 tallest parapets
3. complete all missing hardware as discussed with framer
|
||||
Other/Miscellaneous
Carried Forward
05/06/2024
1. parapet framing on roof approved
2. roof sheeting approved
|
||||
Frame Inspection | Partial Pass | 5/9/2024 | 5/9/2024 | 05/09/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
05/09/2024
1. parapet framing on roof approved
2. roof sheeting approved
|
||||
Other/Miscellaneous
Carried Forward
05/09/2024
1.provide correct washers at plate attachment at roof at elevator shaft
2.roof sheeting at pool and luggage area approved
3. wall sheeting at parapets on upper roof approved except areas where sheeting was not installed to provide access for work not yet performed
|
||||
Energy (Insulation) Inspection | Partial Pass | 5/10/2024 | 5/10/2024 | 05/10/2024 |
Shannon King ((253) 840-6684) | ||||
Energy (Insulation) Inspection | Partial Pass | 5/13/2024 | 5/13/2024 | 05/13/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Frame Inspection | Not Ready | 5/20/2024 | 5/20/2024 | 05/20/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
05/20/2024
1.provide correct washers at plate attachment at roof at elevator shaft
2.roof sheeting at pool and luggage area approved
3. wall sheeting at parapets on upper roof approved except areas where sheeting was not installed to provide access for work not yet performed
|
||||
Other/Miscellaneous
Carried Forward
05/20/2024
1. cancelled on site by contractor
|
||||
Frame Inspection | Not Ready | 5/22/2024 | 5/22/2024 | 05/23/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
05/23/2024
1.provide correct washers at plate attachment at roof at elevator shaft
2.roof sheeting at pool and luggage area approved
3. wall sheeting at parapets on upper roof approved except areas where sheeting was not installed to provide access for work not yet performed
|
||||
Other/Miscellaneous
Resolved
05/23/2024
1. cancelled on site by contractor
|
||||
Other/Miscellaneous
Carried Forward
05/23/2024
1.complete shear in corridor on fifth floor
2. provide blocking at hangers as discussed with contractor
3.contractor to have moisture reading device at time of next inspection to verify acceptable levels of moisture before coving
|
||||
Frame Inspection | Partial Pass | 5/24/2024 | 5/24/2024 | 05/24/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Resolved
05/24/2024
1.complete shear in corridor on fifth floor
2. provide blocking at hangers as discussed with contractor
3.contractor to have moisture reading device at time of next inspection to verify acceptable levels of moisture before coving
|
||||
Comment Building Div Inspection | Partial Pass | 5/28/2024 | 5/28/2024 | 05/28/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
05/28/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Energy (Insulation) Inspection | Partial Pass | 5/31/2024 | 5/31/2024 | 06/01/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Frame Inspection | Partial Pass | 5/31/2024 | 5/31/2024 | 06/01/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/4/2024 | 6/4/2024 | 06/05/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/05/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
06/05/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Energy (Insulation) Inspection | Not Ready | 6/4/2024 | 6/4/2024 | 06/05/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Frame Inspection | Partial Pass | 6/4/2024 | 6/4/2024 | 06/05/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Energy (Insulation) Inspection | Partial Pass | 6/6/2024 | 6/6/2024 | 06/06/2024 |
Shannon King ((253) 840-6684) | ||||
Wallboard / Drywall Inspection | Partial Pass | 6/6/2024 | 6/6/2024 | 06/06/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
06/06/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
06/06/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Carried Forward
06/06/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Comment Building Div Inspection | Partial Pass | 6/7/2024 | 6/7/2024 | 06/07/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
06/07/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Frame Inspection | Failed | 6/11/2024 | 6/11/2024 | 06/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/11/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Frame Inspection | Partial Pass | 6/13/2024 | 6/13/2024 | 06/13/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/13/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Other/Miscellaneous
Carried Forward
06/13/2024
date of inspection 6/13/2024
1.complete items 1 and 2 of previous list
2.provide clarification on off sets
3. complete log cabin at drywall corners
4. not a complete list/not ready
LEVEL ONE
1.areas in corridor where moisture was to high approved for cover
|
||||
Comment Building Div Inspection | Not Ready | 6/17/2024 | 6/17/2024 | 06/17/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/17/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Other/Miscellaneous
Carried Forward
06/17/2024
date of inspection 6/17/2024
1. discussed shaft designs
|
||||
Energy (Insulation) Inspection | Failed | 6/20/2024 | 6/20/2024 | 06/20/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/20/2024
date of inspection 6/20/2024
1. complete insulation of south exterior wall at mech shaft
|
||||
Wallboard / Drywall Inspection | Not Ready | 6/20/2024 | 6/20/2024 | 06/20/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/20/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
06/20/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Carried Forward
06/20/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Other/Miscellaneous
Carried Forward
06/20/2024
LEVEL ONE CORRIDOR DRYWALL
date of inspection 6/20/2024
1. complete areas that were not done at time of inspection
2. it appears that areas where multiple layers of drywall are required it is being covered up with out inspections
|
||||
Frame Inspection | Not Ready | 6/20/2024 | 6/20/2024 | 06/20/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/20/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Other/Miscellaneous
Carried Forward
06/20/2024
date of inspection 6/13/2024
1.complete items 1 and 2 of previous list
2.provide clarification on off sets
3. complete log cabin at drywall corners
4. not a complete list/not ready
LEVEL ONE
1.areas in corridor where moisture was to high approved for cover
|
||||
Other/Miscellaneous
Carried Forward
06/20/2024
date of inspection 6/20/2024
framing of mech shaft at north east exterior wall
1. remove drywall from concrete to roof to perform inspection at exterior wall
|
||||
Plumbing Rough In Inspection | Partial Pass | 6/24/2024 | 6/24/2024 | 06/24/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Resolved
06/24/2024
1.new kitchen area under slab plumbing approved
2. provide as-built of underslab plumbing as discussed with contractor
|
||||
Other/Miscellaneous
Carried Forward
06/24/2024
date of inspection 6/24/2024
1. gas pipe risers from 1st floor to roof approved at 10 psi as noted on page P-310 of city approved plans
2. roof drains approved as marked up on page 309 of city approved plans
FLOOR 5
1. DWV and supply test (supply at 90 psi) approved at rooms 529,527,525,523,524,526,528,530 as marked up on city approved plans page P-21013
FLOOR 4
1. DWV and supply test (supply at 90 psi) approved at rooms 429,427,425,423,424,426,428,430 as marked up on city approved plans page P-208B
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/24/2024 | 6/24/2024 | 06/24/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/24/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
06/24/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Carried Forward
06/24/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Other/Miscellaneous
Carried Forward
06/24/2024
LEVEL ONE CORRIDOR DRYWALL
date of inspection 6/20/2024
1. complete areas that were not done at time of inspection
2. it appears that areas where multiple layers of drywall are required it is being covered up with out inspections
|
||||
Other/Miscellaneous
Carried Forward
06/24/2024
date of inspection 6/24/2024
1. 1st floor corridor top out approved
|
||||
Frame Inspection | Partial Pass | 6/25/2024 | 6/25/2024 | 06/27/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/27/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
date of inspection 6/13/2024
1.complete items 1 and 2 of previous list
2.provide clarification on off sets
3. complete log cabin at drywall corners
4. not a complete list/not ready
LEVEL ONE
1.areas in corridor where moisture was to high approved for cover
|
||||
Other/Miscellaneous
Resolved
06/27/2024
date of inspection 6/20/2024
framing of mech shaft at north east exterior wall
1. remove drywall from concrete to roof to perform inspection at exterior wall
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
date of inspection 6/25/2024
1.drywall first layer in shafts at stacks 218,219,221,224,226,225,229,228,approved as marked up on the city approved on page A-101
2.insulation and vapor barrier at exterior wall of south mech shaft approved as marked up on city approved plans page A-101
|
||||
Wallboard / Drywall Inspection | Partial Pass | 6/26/2024 | 6/26/2024 | 06/27/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/27/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
LEVEL ONE CORRIDOR DRYWALL
date of inspection 6/20/2024
1. complete areas that were not done at time of inspection
2. it appears that areas where multiple layers of drywall are required it is being covered up with out inspections
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
date of inspection 6/24/2024
1. 1st floor corridor top out approved
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
inspection date 6/26/2024
1.first layer of drywall at shafts stacks 208,210,212,213,214,216, approved as marked up on city approved plans page A-101
2.insulation and vapor barrier at exterior wall at north east mech shaft approved as marked up on sheet A-101 of city approved plans
|
||||
Plumbing Rough In Inspection | Partial Pass | 6/27/2024 | 6/27/2024 | 06/27/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/27/2024
date of inspection 6/24/2024
1. gas pipe risers from 1st floor to roof approved at 10 psi as noted on page P-310 of city approved plans
2. roof drains approved as marked up on page 309 of city approved plans
FLOOR 5
1. DWV and supply test (supply at 90 psi) approved at rooms 529,527,525,523,524,526,528,530 as marked up on city approved plans page P-21013
FLOOR 4
1. DWV and supply test (supply at 90 psi) approved at rooms 429,427,425,423,424,426,428,430 as marked up on city approved plans page P-208B
|
||||
Other/Miscellaneous
Carried Forward
06/27/2024
date of inspection 6/27/2024
1.hot water circ line approved as marked up on page P-307 of city approved plans
2. floors 4 and 5 DWV and supply approved as marked up on city approved plans page P-208
3. rain drains approved as marked up on city approved plans page 309
|
||||
Mechanical Rough In Inspection | Not Ready | 6/28/2024 | 6/28/2024 | 06/28/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
06/28/2024
1. this was a comment inspection
2. discussed mech requirements
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/1/2024 | 7/1/2024 | 07/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/02/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
LEVEL ONE CORRIDOR DRYWALL
date of inspection 6/20/2024
1. complete areas that were not done at time of inspection
2. it appears that areas where multiple layers of drywall are required it is being covered up with out inspections
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
date of inspection 6/24/2024
1. 1st floor corridor top out approved
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
inspection date 6/26/2024
1.first layer of drywall at shafts stacks 208,210,212,213,214,216, approved as marked up on city approved plans page A-101
2.insulation and vapor barrier at exterior wall at north east mech shaft approved as marked up on sheet A-101 of city approved plans
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
date of inspection 7/1/2024
1.from elevator south second layer at shafts approved
2. from east to west first layer at shafts approved
3. as marked up on city approved plans PG A-101
|
||||
Plumbing Rough In Inspection | Partial Pass | 7/2/2024 | 7/2/2024 | 07/02/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/02/2024
date of inspection 6/24/2024
1. gas pipe risers from 1st floor to roof approved at 10 psi as noted on page P-310 of city approved plans
2. roof drains approved as marked up on page 309 of city approved plans
FLOOR 5
1. DWV and supply test (supply at 90 psi) approved at rooms 529,527,525,523,524,526,528,530 as marked up on city approved plans page P-21013
FLOOR 4
1. DWV and supply test (supply at 90 psi) approved at rooms 429,427,425,423,424,426,428,430 as marked up on city approved plans page P-208B
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
date of inspection 6/27/2024
1.hot water circ line approved as marked up on page P-307 of city approved plans
2. floors 4 and 5 DWV and supply approved as marked up on city approved plans page P-208
3. rain drains approved as marked up on city approved plans page 309
|
||||
Other/Miscellaneous
Carried Forward
07/02/2024
date of inspection 7/2/2024
1.5th floor dwv and supply approved as marked up on P-210B of city approved plans
2. 4th floor dwv and supply approved as marked up on P-208B of city approved plans
3. rain drains approved as marked up on P-309 of city approved plans
|
||||
Frame Inspection | Partial Pass | 7/3/2024 | 7/3/2024 | 07/03/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/03/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Other/Miscellaneous
Carried Forward
07/03/2024
date of inspection 6/13/2024
1.complete items 1 and 2 of previous list
2.provide clarification on off sets
3. complete log cabin at drywall corners
4. not a complete list/not ready
LEVEL ONE
1.areas in corridor where moisture was to high approved for cover
|
||||
Other/Miscellaneous
Carried Forward
07/03/2024
date of inspection 6/25/2024
1.drywall first layer in shafts at stacks 218,219,221,224,226,225,229,228,approved as marked up on the city approved on page A-101
2.insulation and vapor barrier at exterior wall of south mech shaft approved as marked up on city approved plans page A-101
|
||||
Other/Miscellaneous
Carried Forward
07/03/2024
INSP FOR ROCK ON SHAFTS
1: see highlighted plans for description
2:pre rock behind electrical panels from 2nd floor to 5th floor ok.
|
||||
Mechanical Rough In Inspection | Partial Pass | 7/2/2024 | 7/2/2024 | 07/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/11/2024
1. this was a comment inspection
2. discussed mech requirements
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
date of inspection 7/2/2024
1. 5th floor corridors mech partial approval as marked up on city approved plans pages M-205A and M-205B
2. provide as-built approval from engineer for pipe size changes
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/9/2024 | 7/9/2024 | 07/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/11/2024
NORTH STAIRWELL
1.level 4 and 5 hotel side 2nd layer south and west wall approved
SOUTH STAIRWELL
1.level 5 hotel side 2nd layer north wall approved
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
inspection date 6/4/2024
1.level 4,and 5 corridors lids and 1' down on walls approved
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
1. complete drywall nailing at level 2 ceiling at east to west corridor.
2 ; kevin said level 3 ceiling not approved as discussed with contractor.
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
LEVEL ONE CORRIDOR DRYWALL
date of inspection 6/20/2024
1. complete areas that were not done at time of inspection
2. it appears that areas where multiple layers of drywall are required it is being covered up with out inspections
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
date of inspection 6/24/2024
1. 1st floor corridor top out approved
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
inspection date 6/26/2024
1.first layer of drywall at shafts stacks 208,210,212,213,214,216, approved as marked up on city approved plans page A-101
2.insulation and vapor barrier at exterior wall at north east mech shaft approved as marked up on sheet A-101 of city approved plans
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
date of inspection 7/1/2024
1.from elevator south second layer at shafts approved
2. from east to west first layer at shafts approved
3. as marked up on city approved plans PG A-101
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
date of inspection 7/9/2024
1. 2nd layer of shafts approved as marked up on city approved plans page A-101
|
||||
Comment Building Div Inspection | Partial Pass | 7/10/2024 | 7/10/2024 | 07/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/11/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
date of inspection 6/17/2024
1. discussed shaft designs
|
||||
Other/Miscellaneous
Carried Forward
07/11/2024
1. this was mech R/I inspection
2. 4th floor corridor mech partial approval as marked up on city approved plans pages M-204A and M-204B
3.date of inspection 7/10/2024
|
||||
Wallboard / Drywall Inspection | Not Ready | 7/11/2024 | 7/11/2024 | 07/11/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/11/2024
date of inspection 7/11/2024
this was a comment inspection
discussed mech shaft designs
|
||||
Mechanical Rough In Inspection | Not Ready | 7/15/2024 | 7/15/2024 | 07/15/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Carried Forward
07/15/2024
1. this was a comment inspection
2. discussed mech requirements
|
||||
Other/Miscellaneous
Carried Forward
07/15/2024
date of inspection 7/2/2024
1. 5th floor corridors mech partial approval as marked up on city approved plans pages M-205A and M-205B
2. provide as-built approval from engineer for pipe size changes
|
||||
Other/Miscellaneous
Carried Forward
07/15/2024
1.date of inspection 7/15/2024
2.this was a comment inspection
3. discussed attachment of shaft liner at corridor walls at mech shafts
|
||||
Mechanical Rough In Inspection | Partial Pass | 7/16/2024 | 7/16/2024 | 07/17/2024 |
Kevin Spruell ((253) 841-5590) | ||||
Other/Miscellaneous
Outstanding
07/17/2024
date of inspection 7/16/2024
from south to elevator, floors 1 thru 5 small shaft duct seal approved as marked up on city approved plans page M-202B
|
||||
Comment Building Div Inspection | Partial Pass | 7/18/2024 | 7/18/2024 | 07/18/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/18/2024
NORTH STAIRWELL
1. level 4 southwall hotel side 2nd layer approved
2. level 5 south and west wall provide min lap per UL listing hotel side at 2nd layer
3. level 4 west wall hotel side provide min lap per UL listing 2nd layer
SOUTH STAIRWELL
1. level 5 east wall hotel side 2nd layer approved
|
||||
Other/Miscellaneous
Carried Forward
07/18/2024
date of inspection 6/17/2024
1. discussed shaft designs
|
||||
Other/Miscellaneous
Carried Forward
07/18/2024
1. this was mech R/I inspection
2. 4th floor corridor mech partial approval as marked up on city approved plans pages M-204A and M-204B
3.date of inspection 7/10/2024
|
||||
Frame Inspection | Partial Pass | 7/18/2024 | 7/18/2024 | 07/18/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/18/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Other/Miscellaneous
Carried Forward
07/18/2024
date of inspection 6/13/2024
1.complete items 1 and 2 of previous list
2.provide clarification on off sets
3. complete log cabin at drywall corners
4. not a complete list/not ready
LEVEL ONE
1.areas in corridor where moisture was to high approved for cover
|
||||
Other/Miscellaneous
Carried Forward
07/18/2024
date of inspection 6/25/2024
1.drywall first layer in shafts at stacks 218,219,221,224,226,225,229,228,approved as marked up on the city approved on page A-101
2.insulation and vapor barrier at exterior wall of south mech shaft approved as marked up on city approved plans page A-101
|
||||
Frame Inspection | Partial Pass | 7/19/2024 | 07/19/2024 | |
Shannon King ((253) 840-6684) | ||||
Fire Complaint Inspection | Failed | 7/22/2024 | 07/22/2024 | |
David Drake ((253) 864-4171) | ||||
Fire Inspection Required
Carried Forward
07/22/2024
1. Fuel storage needs vehicle impact protection. Provide ecology blocks or bollards to be compliant with 2018 IFC Section 312.
2. Provide spill kit for fuel storage.
3. Provide Fire Extinguisher for fuel storage.
4. Fire Extinguishers throughout building not tagged. Provide proper tags and certification for all onsite Extinguishers.
5. GC was warned not to cover fire sprinkler piping on roof by Building Inspectors Kevin and Shannon prior to this inspection. All areas can not be visually seen and will not be approved or inspected through holes cut in the walls. Remove all areas that cover fire sprinkler piping prior to next inspection.
6. These areas on the roof will require heat detection if not already shown on the Fire Alarm plans. Heat detectors are required to have 24/7 access to each device. Access hatches will be required for each device. Annual inspections on the fire alarm system will be a challenge if not framed correctly.
7. The fire sprinkler system standpipe FDC connections have no caps and are wide open to vandalism. Requirement, flush standpipe for possibly debris in system from being left open at all floors.
|
||||
Mechanical Rough In Inspection | Not Ready | 7/22/2024 | 7/22/2024 | 07/22/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Carried Forward
07/22/2024
1 ; nobody on-site with access to city approved plans at time of inspection. ( 8:00 am,no access to office)
|
||||
Frame Inspection | Not Ready | 7/22/2024 | 7/22/2024 | 07/22/2024 |
Shannon King ((253) 840-6684) | ||||
Other/Miscellaneous
Outstanding
07/18/2024
inspection date 6/11/2024
1. remove drywall in areas where covered with out energy/vapor barrier inspections
2.complete fasteners per listing
3. complete framing at shafts
4. not a complete list / not ready
|
||||
Other/Miscellaneous
Outstanding
07/18/2024
date of inspection 6/13/2024
1.complete items 1 and 2 of previous list
2.provide clarification on off sets
3. complete log cabin at drywall corners
4. not a complete list/not ready
LEVEL ONE
1.areas in corridor where moisture was to high approved for cover
|
||||
Other/Miscellaneous
Outstanding
07/18/2024
date of inspection 6/25/2024
1.drywall first layer in shafts at stacks 218,219,221,224,226,225,229,228,approved as marked up on the city approved on page A-101
2.insulation and vapor barrier at exterior wall of south mech shaft approved as marked up on city approved plans page A-101
|
||||
Other/Miscellaneous
Outstanding
07/22/2024
1 ; nobody on-site with access to city approved plans at time of inspection. ( 8:00 am,no access to office)
|
||||
Frame Inspection | Partial Pass | 7/24/2024 | 7/24/2024 | 07/24/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/24/2024
1:east to west corridor shafts as highlighted and dated on plans ok to include big shafts off of north and south corridors
|
||||
Firewall/Firestop Inspection | Partial Pass | 7/24/2024 | 7/24/2024 | 07/24/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/24/2024
1:firestopping progressing at head of wall in units off of east and west corridors
|
||||
Wallboard / Drywall Inspection | Partial Pass | 7/24/2024 | 7/24/2024 | 07/24/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/24/2024
see shaftwall framing highlighted and dated on plans
|
||||
Plumbing Rough In Inspection | Partial Pass | 7/25/2024 | 7/25/2024 | 07/25/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Carried Forward
07/25/2024
date of inspection 6/24/2024
1. gas pipe risers from 1st floor to roof approved at 10 psi as noted on page P-310 of city approved plans
2. roof drains approved as marked up on page 309 of city approved plans
FLOOR 5
1. DWV and supply test (supply at 90 psi) approved at rooms 529,527,525,523,524,526,528,530 as marked up on city approved plans page P-21013
FLOOR 4
1. DWV and supply test (supply at 90 psi) approved at rooms 429,427,425,423,424,426,428,430 as marked up on city approved plans page P-208B
|
||||
Other/Miscellaneous
Carried Forward
07/25/2024
date of inspection 6/27/2024
1.hot water circ line approved as marked up on page P-307 of city approved plans
2. floors 4 and 5 DWV and supply approved as marked up on city approved plans page P-208
3. rain drains approved as marked up on city approved plans page 309
|
||||
Other/Miscellaneous
Carried Forward
07/25/2024
date of inspection 7/2/2024
1.5th floor dwv and supply approved as marked up on P-210B of city approved plans
2. 4th floor dwv and supply approved as marked up on P-208B of city approved plans
3. rain drains approved as marked up on P-309 of city approved plans
|
||||
Other/Miscellaneous
Carried Forward
07/25/2024
1:dwv and supply to include rain leaders approved as highlighted on plans for this date.
|
||||
Frame Inspection | Partial Pass | 7/25/2024 | 7/25/2024 | 07/25/2024 |
Monty Johnson ((253) 770-3326) | ||||
Other/Miscellaneous
Outstanding
07/25/2024
shaft wall framing as highlighted and dated on plans
|
||||
Wallboard / Drywall Inspection | Not Ready | 7/25/2024 | 7/25/2024 | 07/25/2024 |
Monty Johnson ((253) 770-3326) |
Condition | Status | Department | Category | Expiration Date | Due Date |
---|---|---|---|---|---|
General Permit Conditions | Resolved | Building Division | Standard Conditions | ||
:
* Final approval by the Building Official is required prior to use or occupancy.
* Work shall not proceed until the inspector has approved the stages of construction.
* Surface storm water shall be diverted from the building site and shall not drain onto adjacent properties.
* I hereby acknowledge that I have read this Permit/Application, that the information given is correct; that I am the owner or the duly authorized agent of the owner; that plans submitted herewith are in compliance with all applicable city, county and state laws and that all construction will proceed in accordance with said laws. This permit shall expire if work is not commenced with 180 days or if the work is suspended for a period of 180 days. Permits expire two years from issuance.
* By leaving the contractor information section blank, I hereby certify further that contractors (general or subcontractors) will not be hired to perform any work in association with this permit. I also certify that if I do choose to hire a contractor (general or subcontractor) I will only hire those contractors that are licensed by the State of Washington.
* TO SCHEDULE INSPECTIONS, CHECK PERMIT STATUS OR TO MAKE PAYMENTS ON THE CITY WEB SITE VISIT https://secure.cityofpuyallup.org/
|
|||||
Engineering Commercial Standard Conditions | Resolved | Engineering Division | Standard Conditions | ||
:
* Prior to STARTING site work; request inspection for Erosion and Sediment - Inspection Code # 1010; Inspection request line phone 1-877-232-6456
** OCCUPANCY WILL NOT BE GRANTED UNTIL ALL CIVIL WORK ASSOCIATED WITH E-20-0070 IS COMPLETED AND APPROVAL HAS BEEN PROVIDED **
* THE APPLICANT IS RESPONSIBLE TO CALL THE INSPECTION LINE AT 877-232-6456 TO SCHEDULE INSPECTIONS. UTILITY INSPECTIONS ARE REQUIRED PRIOR TO BACKFILLING.
** STORMWATER CONTROL OF ROOF DOWNSPOUTS MUST BE CONTROLLED. ATTACHED TO THE SITE PLAN IS A TYPICAL INFILTRATION SYSTEM YOU MAY CHOOSE TO FOLLOW. FOR ANY QUESTIONS CALL MARCUS SEDLICKAS, ENGINEERING INSPECTOR, AT 253-405-1707
** SEDIMENT CONTROL AND EROSION PROCEDURES SHALL BE PRACTICE TO ELIMINATE AND PREVENT OFF SITE DAMAGE. STORMWATER RUNOFF ORIGINATING UPGRADE OF EXPOSED AREAS SHALL BE CONTROLLED TO REDUCE EROSION AND SEDIMENT LOSS DURING THE PERIOD OF EXPOSURE. SEE CIVIL PERMIT E-20-0070
* The builder/owner shall be responsible for keeping the existing right-of-way free of debris and dirt. Any violation of PMC Chapter 21.14 pertaining to clearing, filling and grading, erosion and sediment control, and storm water discharges shall be prosecuted to the fullest extent of the law.
* Any addition/expansion to the foot print of the building including decks and porches not originally shown on the approved set of plans must obtain proper permits prior to construction.
* The applicant is responsible to call the Utility Notification Center at 1-800-424-5555 before beginning any excavation. Call before you dig, it's the law.
* No work shall be done in or on the public right of way without a licensed and bonded contractor first obtaining a right of way permit.
* Any code requirement that may have been overlooked in this plan review does not imply that the requirements have been waived.
|
|||||
Building Permit Standard Conditions | Resolved | Building Division | Standard Conditions | ||
:
PERMIT CONDITIONS:
1- COMPLY WITH 2015 IFC AND 2015 IBC
2- TOTAL COVERAGE REQUIRED IN THE CITY OF PUYALLUP
3- EXIT LIGHTING TEST REQUIRED CONTRACTOR TO PROVIDE LIGHT METER
4- EMERGENCY RADIO TEST REQUIRED COMPLY WITH IFC SECTION 510. FIRE FINAL APPROVAL APON COMPLETED TEST RESULTS
5- SEPERATE PERMITS ARE REQUIRED FOR FIRE ALARM AND FIRE SPRINKLER.
6- RTU'S, AND SMOKE DAMPNERS WILL BE REQUIRED TO BE TESTED FOR SHUT DOWN.
7- FIRE EXTINGUISHERS REQUIRED PER CODE
8- A KNOX BOX IS REQUIRED AT THE FRONT ENTRY ON THE EXTERIOR OF THE BUILDING
9- PIV MUST HAVE A KNOX LOCK OR APPROVED LOCK WITH AN EXTRA KEY PROVIDED IN KNOX BOX
10- CONTACT CENTRAL PIERCE FIRE & RESCUE FOR KNOX BOX LOCKING ONCE BUILDING KEYS ARE AVALIABLE
11- ALL ABOVE ITEMS TO BE COMPLETED PRIOR TO FIRE FINAL. FIRE FINAL REQUIRED BEFORE BUILDING FINAL
INSPECTION REQUEST CODES:
2252 EXIT LIGHT TEST
5610 EMERGENCY RADIO TEST
9200 FIRE BUILDING FINAL
SCHEDULE YOUR INSPECTION BY PHONE OR ONLINE THROUGH THE CITY OF PUYALLUP ONLINE PERMIT SYSTEM. THEN CALL MORNING OF INSPECTION BETWEEN 7AM - 8PM TO SET UP A TIME. INSPECTIONS ARE MONDAY - THURSDAY THERE WILL BE NO INSPECTIONS ON FRIDAYS.
HTTPS://SECURE.CITYOFPUYALLUP.ORG/
INSPECTION LINE 1-877-232-6456 (USE MUTE TO AVOID BACKGROUND NOISE)
DAVID DRAKE AT 253-864-4171 OR RAY COCKERHAM AT 253-841-5585
|
|||||

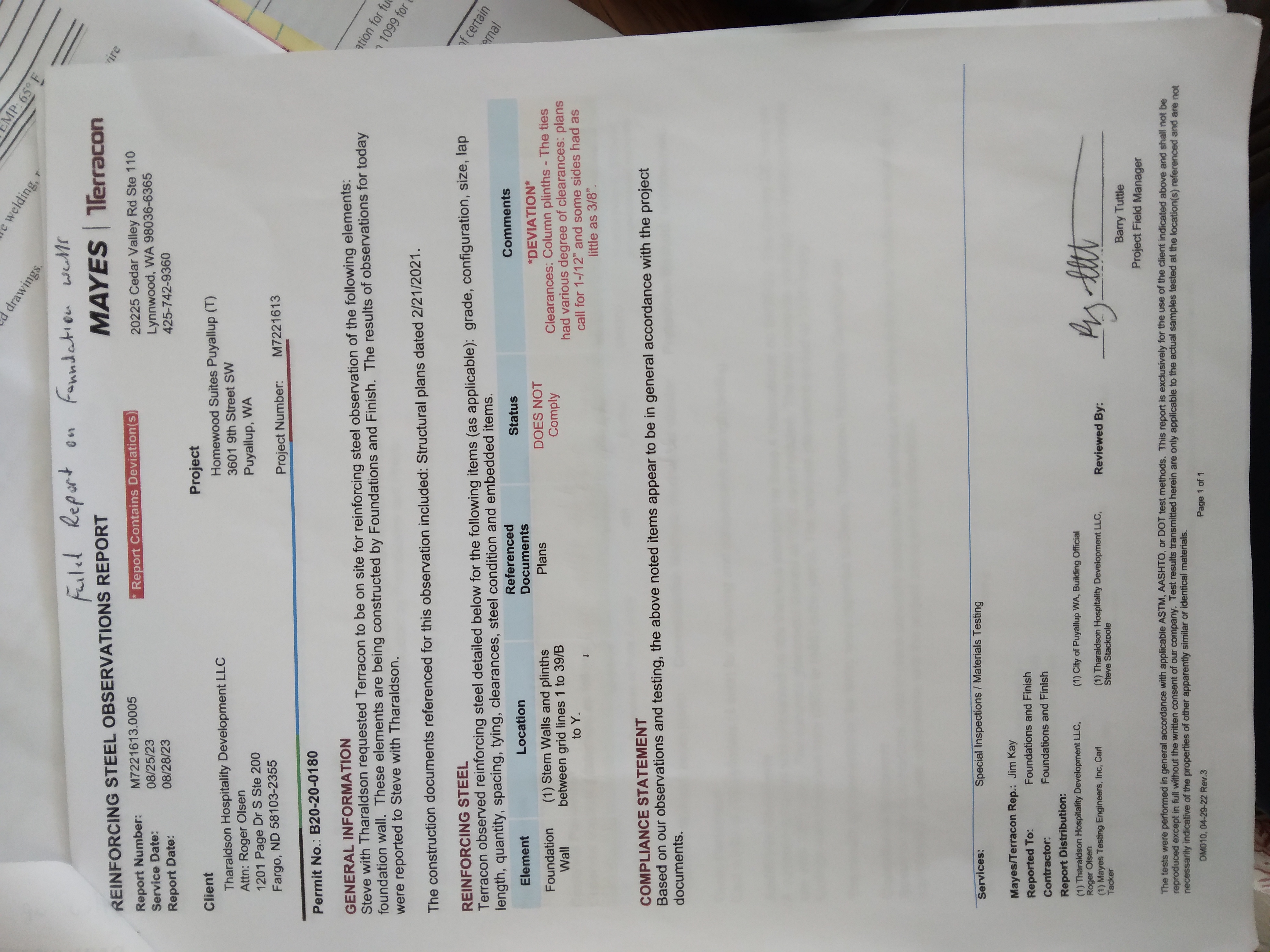

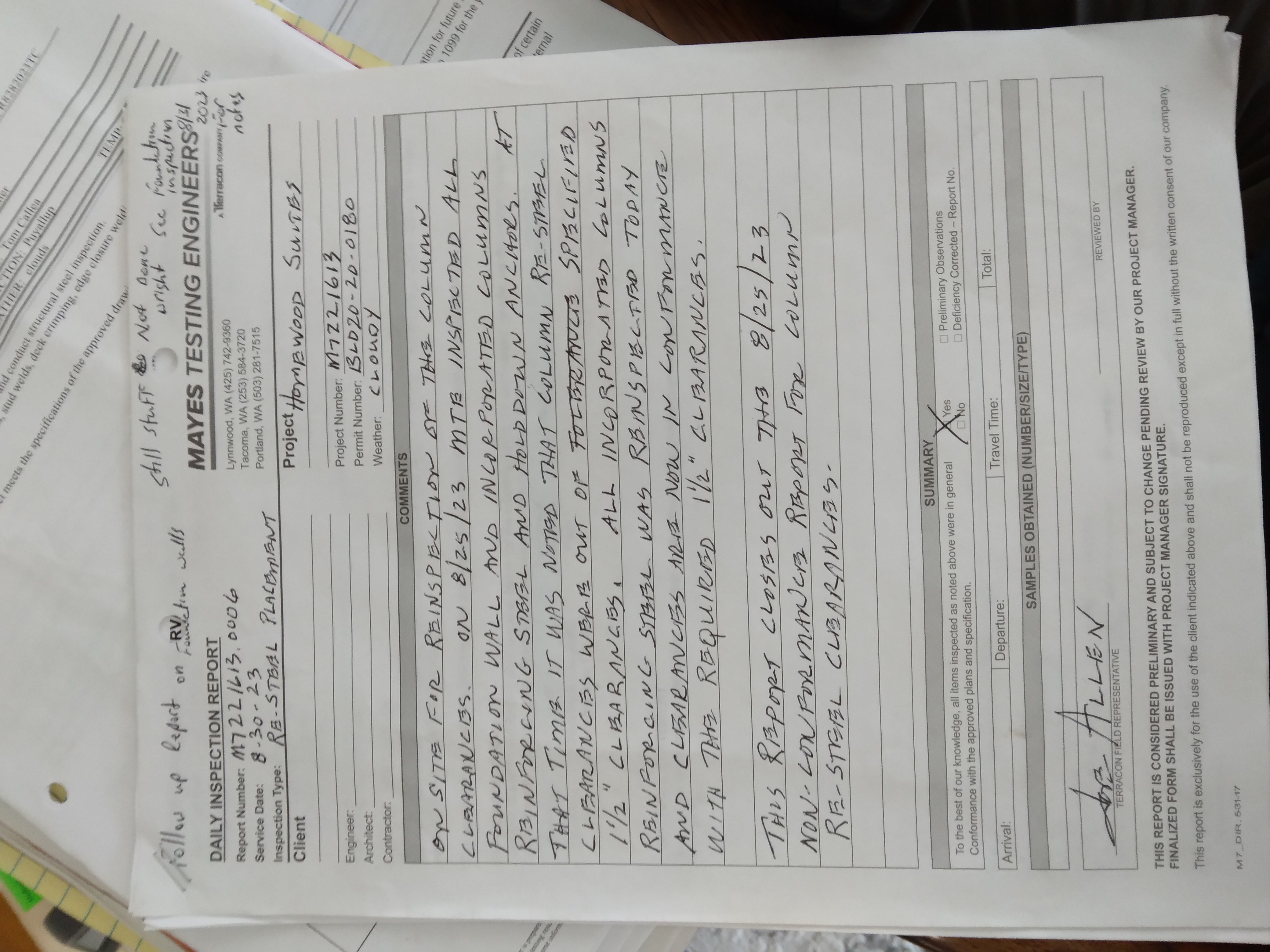

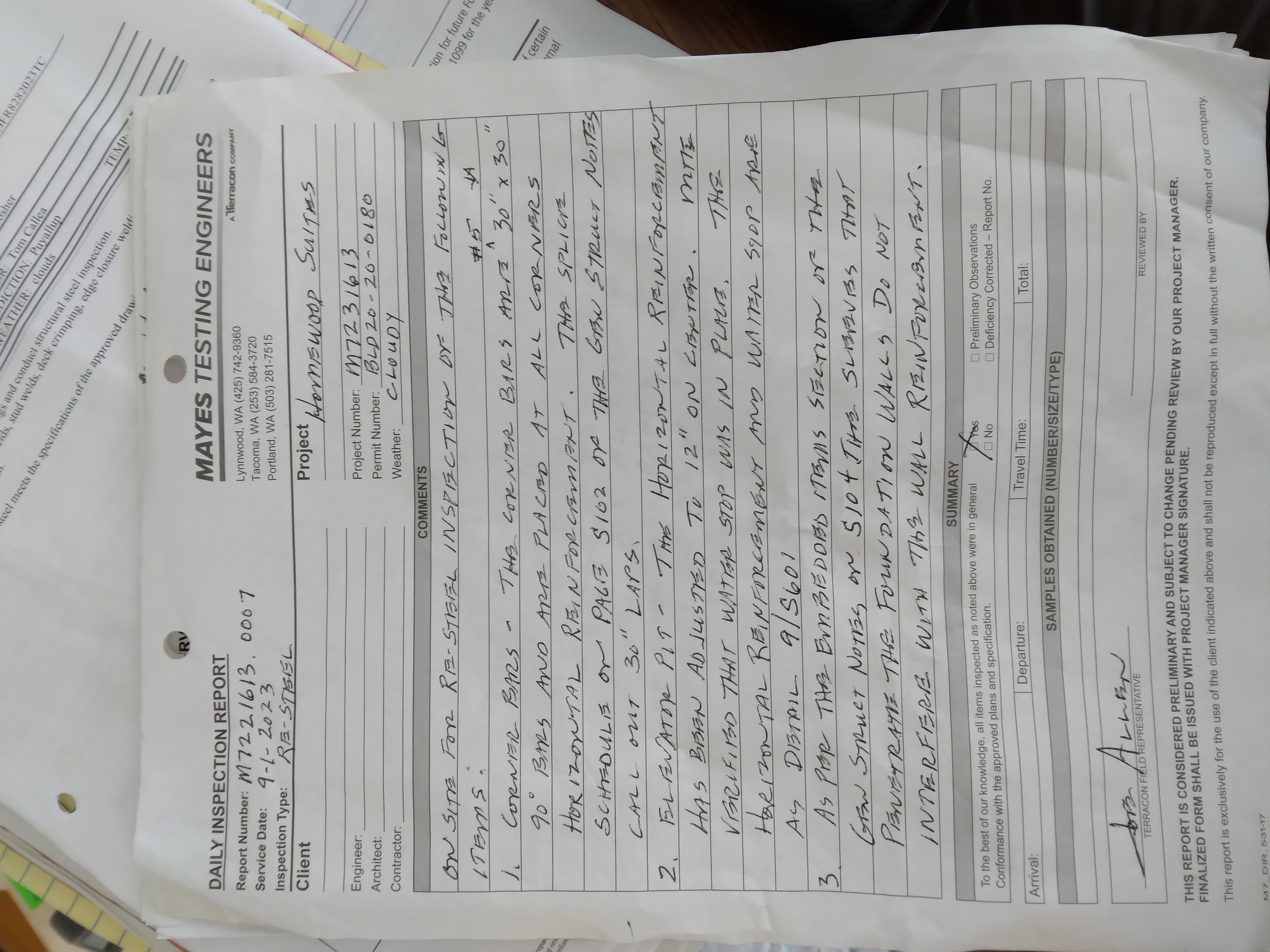

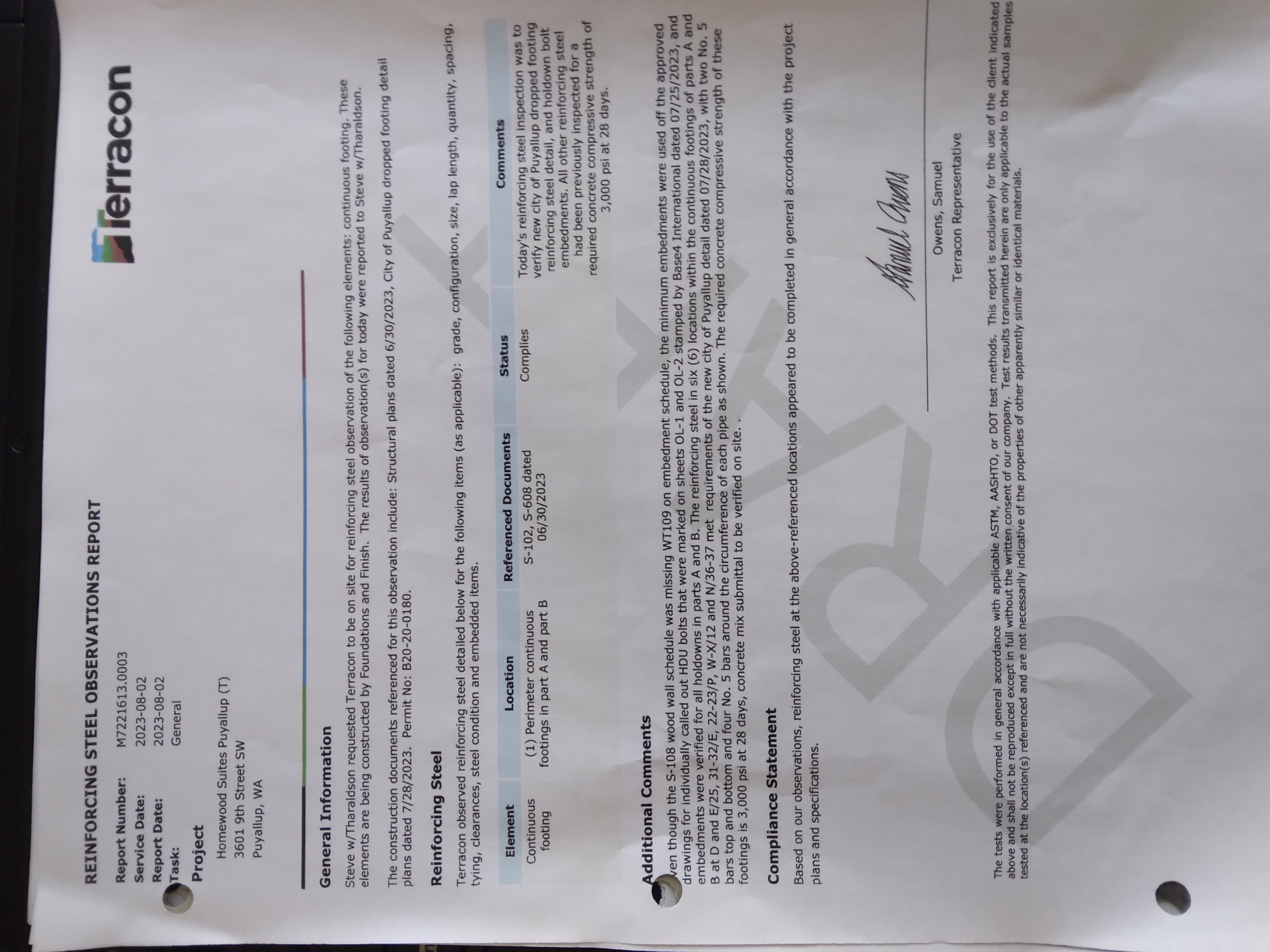

Pipeline Notfication Rcw 19.122.033 | Resolved | Engineering Division | Standard Conditions | ||
:
Effective January 1, 2013 RCW 19.122 Before conducting any construction or excavation within 100 feet of a right-of-way or utility easement containing a transmission pipeline a person must notify the pipeline companies of the scheduled excavation through the one-number locator service 811. Notification must occur in a window of not less than 2 business days but not more than 10 business days before beginning the excavation. If a transmission pipeline company is notified that excavation work will occur near a pipeline, a representative of the company must consult with the excavator on-site prior to excavation.
|
|||||
Miscellaneous Condition | Open | Engineering Division | Prior to Occupancy | ||
:
OFFSITE CIVIL PERMIT E-21-0542 MUST BE COMPLETED PRIOR TO OCCUPANCY
|
|||||
Payment of Deferred Impact Fees | Open | Development & Permitting Services | Prior to Completion | ||
:
Payment of Deferred Impact Fees must be paid within 18 months of permit issuance or prior to scheduling Final Building Inspection (which ever comes first).
|
Reference Number | Status | Type |
---|---|---|
E-20-0070 | Issued | Civil Construction Permit |
E-20-0283 | Closed | Alternative Methods / Materials Request |
PRDE20220405 | Closed | Demolition |
PRFS20240423 | Permit(s) Issued | Fire Sprinklers |
PRCWSA20240533 | Closed | Certificate of Water/Sewer Availability |
PRFA20240566 | Permit(s) Issued | Fire Alarms |
PRCCP20240922 | In Plan Check | Civil Construction Permit |
