Engineering Permit Application Status

PRCCP20250096


In order to request inspections, you need to be signed in.

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRCCP20250096
Civil Construction Permit
Closed
BPLC PROPERTIES LLC
BPLC North site civil submittal. This is a new submittal to replace previous submittal E-21-0071. - PROVAC
01/20/2025
07/02/2025
07/29/2026
01/30/2026

Locations

Reviews

Documents Returned For Corrections

Date Returned Name
05/23/2025 CIVIL PLANS - RESUB (Stamped)
Review Type Outcome Est. Completion Date Completed
Engineering Civil Review Approved 05/28/2025 05/22/2025
Planning Review Approved 05/28/2025 05/16/2025
Fire Review Approved 05/28/2025 05/12/2025
Engineering Traffic Review Approved 05/28/2025 05/07/2025
Public Works Streets Review Approved 05/28/2025 05/06/2025
Public Works Water Review Approved 05/28/2025 05/06/2025
Public Works Collection Review Approved 05/28/2025 05/06/2025
Planning Review Approved 03/28/2025 03/31/2025
Public Works Collection Review Approved 03/28/2025 03/31/2025
Engineering Civil Review Failed 03/28/2025 03/28/2025
Engineering Traffic Review Failed 03/28/2025 03/25/2025
Public Works Water Review Approved 03/28/2025 03/14/2025
Public Works Streets Review Approved 03/28/2025 03/12/2025
Fire Review Failed 03/28/2025 03/11/2025

Fees

Paid Fees Amount Paid Owing Date Paid
Engineering Inspection Fee (3%) $13,500.63 $13,500.63 Paid 06/02/2025
Engineering Permit Fee $300.00 $300.00 Paid 06/02/2025
Traffic Control Permit Fee $50.00 $50.00 Paid 01/21/2025
Traffic Control Plan Review Fee $40.00 $40.00 Paid 01/21/2025
Civil Review Fee $470.00 $470.00 Paid 01/21/2025
Record Drawing Review Fee $200.00 $200.00 Paid 01/21/2025
Civil Review Additional Fee $720.00 $720.00 Paid 04/29/2025
Civil Review Additional Fee $360.00 $360.00 Paid 06/02/2025
Storm System Development Charge - Commercial $49,758.00 $49,758.00 Paid 06/02/2025
Planning Landscape Review Fee $180.00 $180.00 Paid 06/02/2025
Miscellaneous Fee $335.50 $335.50 Paid 10/01/2025
$180.00
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


Permit(s) will not be issued until outstanding fees have been paid in full. Fee details shown above only include currently payable fees, there might be addtional fees to be paid before issuance.

$0.00

Inspections

Inspection Outcome Requested Scheduled Date Inspected
Job Start Inspection Passed 7/7/2025 07/08/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/8/2025 07/08/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/9/2025 07/10/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/10/2025 07/10/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/11/2025 07/11/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/14/2025 07/14/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/15/2025 07/15/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/16/2025 07/16/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/17/2025 07/17/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/18/2025 07/18/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/21/2025 07/21/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/22/2025 07/22/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/23/2025 07/24/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/24/2025 07/24/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/25/2025 07/25/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/28/2025 07/28/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/29/2025 07/29/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/30/2025 07/30/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 7/31/2025 07/31/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/4/2025 08/04/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/5/2025 08/05/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/6/2025 08/06/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/7/2025 08/07/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/11/2025 08/11/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/12/2025 08/12/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/13/2025 08/13/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/14/2025 08/14/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/15/2025 08/15/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/18/2025 08/19/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/19/2025 08/19/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/21/2025 08/21/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/25/2025 08/25/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/26/2025 08/26/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/27/2025 08/27/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 8/29/2025 08/29/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/9/2025 09/09/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/10/2025 09/10/2025
Michael Rosenau ((253) 344-6753)
Engineering Preconstruction Inspection (Pre-Con Meeting) Passed 09/12/2025
Michael Rosenau ((253) 344-6753)
Erosion And Sediment Inspection Passed 9/15/2025 09/15/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/15/2025 09/16/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/18/2025 09/18/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/19/2025 09/22/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/22/2025 09/22/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 9/24/2025 09/24/2025
Michael Rosenau ((253) 344-6753)
Planning Landscape Inspection Passed 9/19/2025 9/24/2025 09/24/2025
Rachael N. Brown ((253) 770-3363)
Engineering Daily Inspection Partial Pass 10/20/2025 10/20/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 10/27/2025 10/27/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 12/22/2025 12/22/2025
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Partial Pass 1/16/2026 01/16/2026
Michael Rosenau ((253) 344-6753)
Engineering Daily Inspection Passed 1/23/2026 1/23/2026 01/23/2026
Michael Rosenau ((253) 344-6753)
Engineering Punchlist Inspection Passed 1/23/2026 1/23/2026 01/23/2026
Michael Rosenau ((253) 344-6753)
Engineering Final Inspection Not Ready 1/23/2026 01/26/2026
Michael Rosenau ((253) 344-6753)
Engineering Final Inspection Passed 01/30/2026
Robin Loewen ((253) - )

Conditions

Condition Status Category
Civil Standard Conditions Open Standard Conditions
Engineering Division
Development Engineering standard civil construction conditions: 1.            Construction permitted as per approved civil plans. 2.            Construction permit shall expire by limitation and be declared void if: a.            Work is not started within 180 days of obtaining the permit. b.            Work is abandoned for 180 days or more after beginning work. c.             After two years from the date of permit issuance, regardless of whether work is finished. 3.            Any changes to the scope of work approved on the civil plans shall be submitted on a Plan Change Request to the Engineering Services Staff for review. 4.            Any changes that require a request to vary from the design standards approved on the civil plans shall be submitted on an Alternative Methods or Construction Materials Request along with an application fee to the Engineering Services Staff for review. 5.            The applicant is responsible to call the Utility Notification Center at 1-800-424-5555 before beginning any excavation.  Call before you dig, it's the law. NOTE:  Effective January 1, 2013, RCW 19.122 - Before conducting any construction or excavation within 100 feet of a right-of-way or utility easement containing a transmission pipeline, a person must notify the pipeline companies of the scheduled excavation through the one-number locator service 811.  Notification must occur in a window of not less than 2 business days, but not more than 10 business days before beginning the excavation.  If a transmission pipeline company is notified that excavation work will occur near a pipeline, a representative of the company must consult with the excavator on-site prior to excavation.  6.            It is the responsibility of the applicant/property owner to obtain all necessary approvals/permits from state, federal, and other agencies that have regulatory authority. 7.            Should the City become aware of conditions that invalidate the original design data used to obtain the permit or determine that the applicant is not complying with the conditions of the permit or approved plans, the City may revoke the original permit and/or order work stopped on the project. The City may require the owner to submit a new application for review and approval. 8.            All work associated with the Site Development Permit must be completed and approved by the City prior to receiving final approval of building permits. 9.            I hereby acknowledge that I have read and understand the contents of this permit and I hereby state that the information I have supplied is true and correct. Indemnification / Hold Harmless The Permittee shall defend, indemnify and hold the Public Entity, its officers, officials, employees and volunteers harmless from any and all claims, injuries, damages, losses or suits including attorney fees, arising out of or in connection with activities or operations performed by the Permittee or on the Permittee's behalf out of issuance of this Permit, except for injuries and damages caused by the sole negligence of the Public Entity. However, should a court of competent jurisdiction determine that RCW 4.24.115 applies to this Permit, then the Permittee agrees to defend, indemnify and hold the Public Entity, its officers, officials, employees and volunteers harmless to the maximum extent permitted thereunder.   It is further specifically and expressly understood that the indemnification provided herein constitutes the Permittee's waiver of immunity under Industrial Insurance, Title 51 RCW, solely for the purposes of this indemnification.  This waiver has been mutually negotiated by the parties.  The provisions of this section shall survive the expiration or termination of this Agreement. to this Permit, then the Permittee agrees to defend, indemnify and hold the Public Entity, its officers, officials, employees and volunteers harmless to the maximum extent permitted thereunder. It is further specifically and expressly understood that the indemnification provided herein constitutes the Permittee's waiver of immunity under Industrial Insurance, Title 51 RCW, solely for the purposes of this indemnification. This waiver has been mutually negotiated by the parties. The provisions of this section shall survive the expiration or termination of this Agreement.
Pre-Construction Meeting Resolved Prior to Issuance
Engineering Division
Please contact the DPS Support Specialist, Robin Loewen at RLOEWEN@PUYALLUPWA.GOV to request a pre-construction meeting prior to starting site work.
Performance Bond Resolved Prior to Issuance
Engineering Division
A Performance Bond must be received by the City of Puyallup prior to permit issuance. The Performance Bond shall be 150% of the estimated cost of work in the ROW per the approved cost estimate received prior to plan approval (attached in CityView Portal under Documents & Images section). See https://www.cityofpuyallup.org/DocumentCenter/View/16622/Performance-Bond-51122-appvd-by-Legal for more information.
Inadvertent Discovery Plan (IDP) Resolved Prior to Issuance
Engineering Division
Email a signed Inadvertent Discovery Plan to RLOEWEN@PUYALLUPWA.GOV.
Overtime Inspection and Watermain Shutdown Fee Resolved Prior to Issuance
Engineering Division
Overtime Inspection Fees / Main Shutdown Fees form is to be received prior to permit issuance. Signing this form is acknowledgement that there may be billed overtime inspection fees per the current fee schedule and that whenever the City Water Division staff is required to perform a mainline shutdown the fees shall be billed at $134.00 per event plus $10.00 per tag. Instances when a shutdown is performed outside regular working hour’s additional overtime fees will be billed at the current overtime billing rate (3 hour minimum call out time).
Certificate of Insurance/CG2012 Resolved Prior to Issuance
Engineering Division
Certificate or Insurance/CG2012 must be received prior to issuance
Clear, Fill, and Grade Bond Resolved Prior to Issuance
Engineering Division
A Clear, Fill and, Grade Bond must be received by the City of Puyallup prior to permit issuance. The amount of the bond shall not be less than the total estimated construction cost of the interim and permanent erosion and sediment control measures per the approved cost estimate received prior to plan approval. See https://www.cityofpuyallup.org/DocumentCenter/View/16621/CFG-Bond-101822-appvd-by-Legal for more information.
Miscellaneous Condition Resolved Prior to Issuance
Development & Permitting Services
Attention to the Building Permit, B-21-0263, now PRCTI20250103. It has outstanding fees and inspections for unpermitted work. This permit shall be ready to issue prior to this civil permit being issued. [Jamie Carter @ 03/25/2025 3:20 PM]
Miscellaneous Condition Resolved SEPA Condition
Planning Division
SEPA Mitigation Measure - Environmental Health: The use of the site for a vactor truck business, which involves the use of a vacuum truck that has a pump designed to pneumatically suck liquids, sludges, slurries, or the like from a location into the tank of the truck, could feasibly result in environmental health impacts such as contamination of surface waters from liquids contained within the tank if not properly mitigated. Required mitigation shall include: a. Decanting of any materials contained within the vactor trucks shall be performed at facilities licensed by a local Department of Health. b. Vactor trucks shall be dumped and washed offsite and returned to the facility at 2511 INTER AVE clean and empty. c. Fueling of all trucks, including but not limited to vactor trucks, shall be done offsite.
Miscellaneous Condition Resolved SEPA Condition
Planning Division
Miscellaneous Condition Resolved Prior to Issuance
Traffic Division
Provide a Traffic Control Plan on 3rd submittal See City Standard TCP's 7 & 11
Miscellaneous Condition Open Standard Conditions
Development & Permitting Services
Coordinate with the city prior to initiating paving and street light installation. Coordination opportunities exist as the city is paving portions of Inter Ave this year and another project on the north side of Inter Ave (EJ Poultry - Parcel #2105200150) is proposing to install street lights with a connection to the cabinet that is east of this project within a similar time frame.
Ready to Issue - Need Contractor Info Resolved Prior to Issuance
Development & Permitting Services
Must provide Contractor doing the work to be named on permit. Contractor must be registered with Washington State Labor and Industries AND have a valid City of Puyallup business license endorsement with Washington State Department of Revenue.
Performance Bond Resolved Prior to Issuance
Engineering Division
A Stormwater Performance Bond must be received by the City of Puyallup prior to permit issuance. The Stormwater Performance Bond shall be 125% of the estimated cost of stormwater facility construction or improvement per the approved cost estimate received prior to plan approval (attached in CityView Portal under Documents & Images section). See https://www.cityofpuyallup.org/DocumentCenter/View/18269/STORMWATER-Performance-Bond- for more information.
Punchlist: Engineering staff to contact the Planning Department project reviewer to request landscape walkthrough inspection Resolved Misc. Punchlist Section A
Development & Permitting Services
Engineering staff to contact the Planning Department project reviewer to request landscape walkthrough inspection. Landscape requirements to be added to the punchlist.
Punchlist: Provide the City with an electronic version of the record drawings Resolved Misc. Punchlist Section B
Development & Permitting Services
Provide the City with an electronic version of the record drawings in PDF format and in AutoCAD Map 2007 or newer in State Plane South Projection format.
Punchlist: Provide the City a letter from the Design Engineer for the proper install of the stormwater BMP’s Resolved Storm Punchlist Section A
Development & Permitting Services
Provide the City with a letter from the design engineer certifying the proper installation of permanent stormwater controls and compliance with the stormwater site plan.
Punchlist: Miscellaneous Water A Item Resolved Water Punchlist Section A
Development & Permitting Services
Install sampling port on new 4" water service per note 10 on City Standard Detail 03.03.03.
Punchlist: Miscellaneous Stormwater A Item Resolved Storm Punchlist Section A
Development & Permitting Services
Install catch basin markers on new catch basins. City to provide CB markers and adhesive.
Punchlist: Miscellaneous Streets B Item Resolved Street Punchlist Section B
Development & Permitting Services
Provide and install new streetlights per approved plans. Pull-in and connect conductors to provide a fully functional system per approved plans. Once connections are inspected in J-boxes weld J-box lids per note 8 on City Standard 01.06.01.
Punchlist: Miscellaneous Streets A Item Resolved Street Punchlist Section A
Development & Permitting Services
Remove and replace cracked concrete approach panels and curb & gutter.
Punchlist: Miscellaneous Water A Item Resolved Water Punchlist Section A
Development & Permitting Services
Raise existing water meter box to grade in landscape planter behind new City sidewalk on the west end of the site.
Punchlist: Miscellaneous Water A Item Resolved Water Punchlist Section A
Development & Permitting Services
Complete tamper switch install for new PIV.
Punchlist: Miscellaneous Stormwater B Item Resolved Storm Punchlist Section B
Engineering Division
Air test the 12" storm drain from CB # 2 to CB # 1 and CB # 1 to the existing CB # 4.
Punchlist: Miscellaneous Stormwater A Item Resolved Storm Punchlist Section A
Development & Permitting Services
Clean all the new and existing storm system.
Punchlist: Miscellaneous Streets A Item Resolved Street Punchlist Section A
Development & Permitting Services
Install "No Parking" signs.
Punchlist: Miscellaneous Streets A Item Resolved Street Punchlist Section A
Development & Permitting Services
Paint and Stencil "Fire Lane" on curbing.
Punchlist: Provide DDCVA Test Results Resolved Water Punchlist Section A
Engineering Division

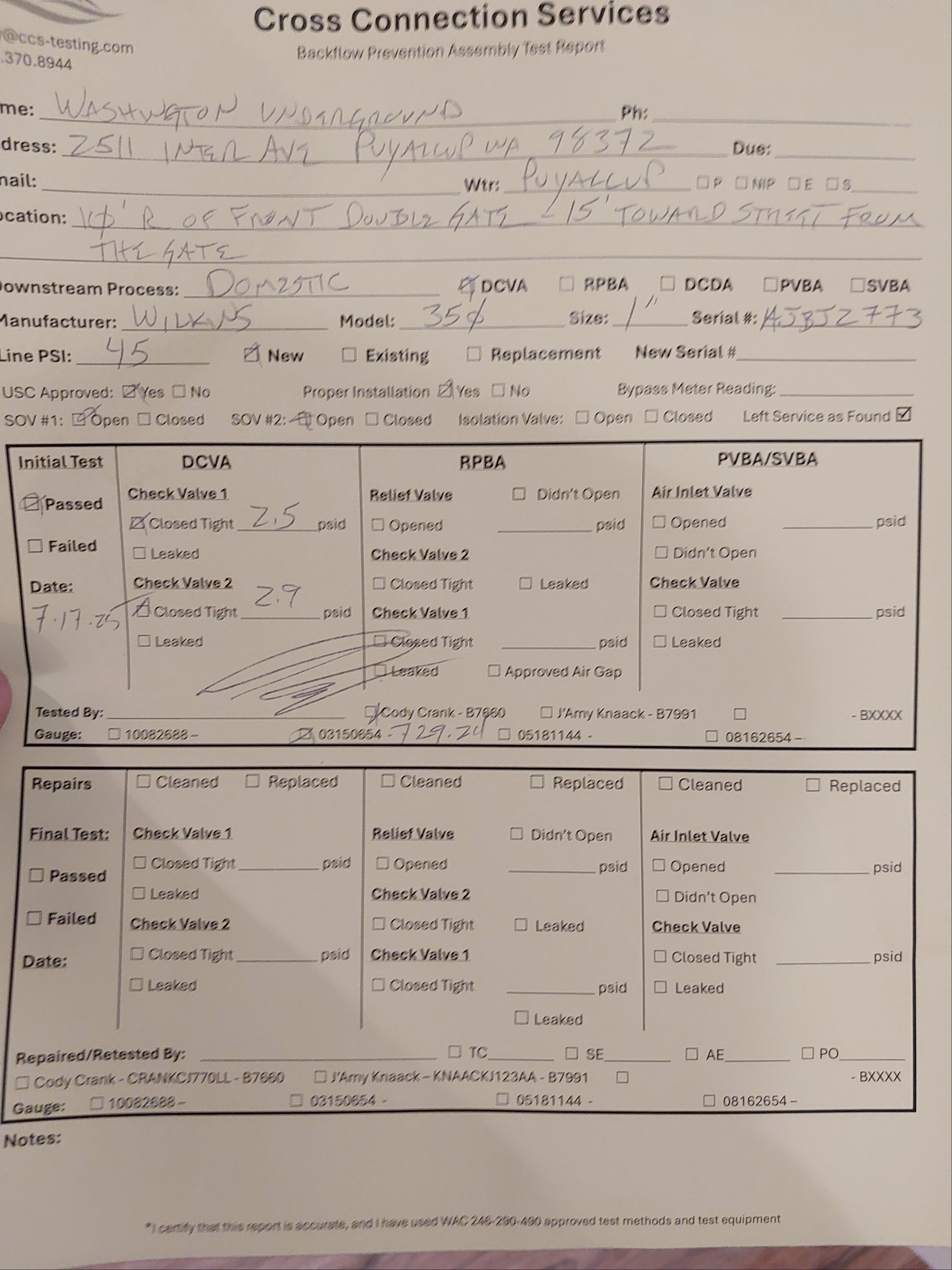

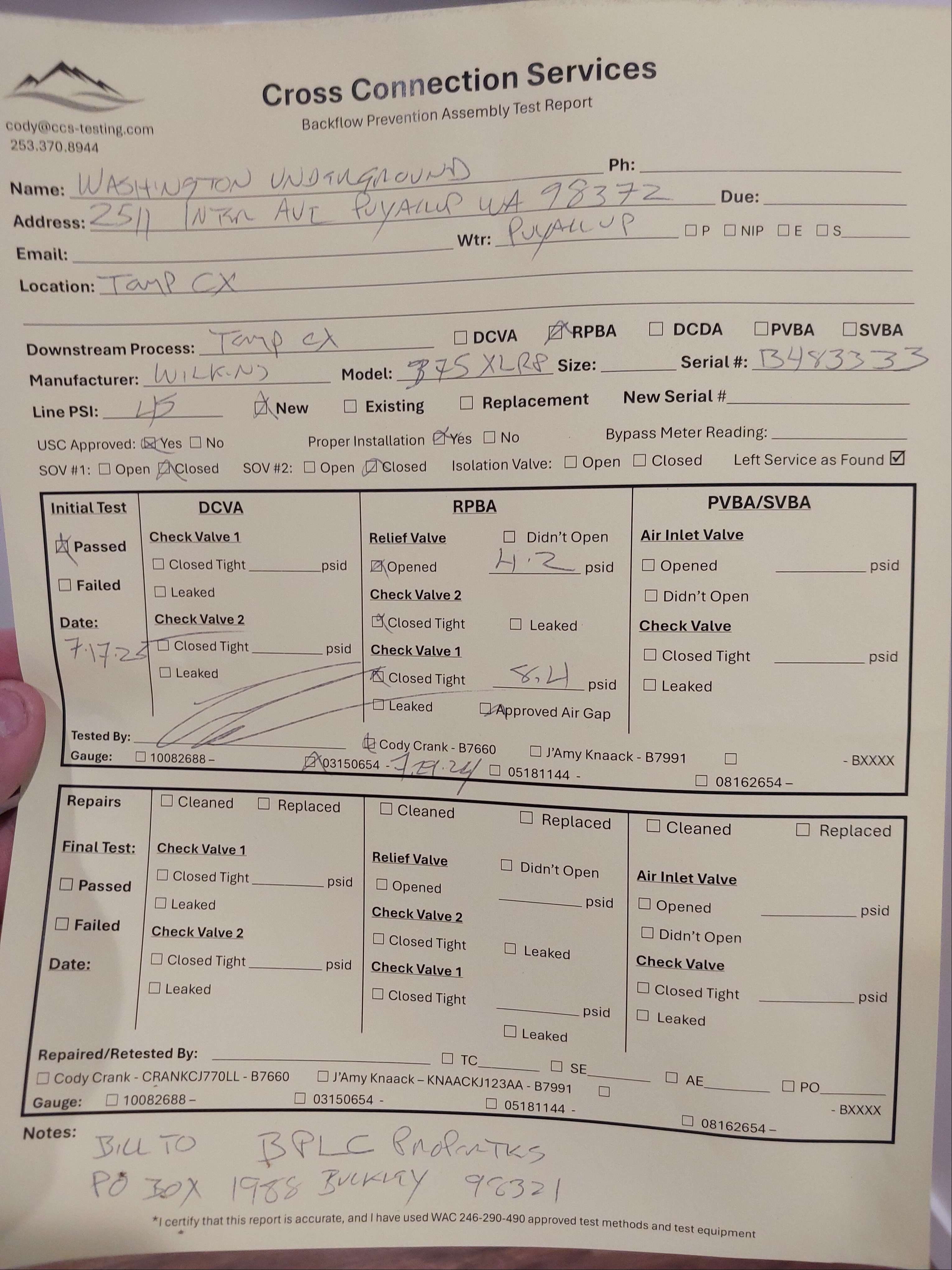

Provide the City with the test results for the Double Detector Check Valve Assembly (DDCVA).
Punchlist: Provide the City with a signed stormwater agreement Resolved Storm Punchlist Section B
Engineering Division
Provide the City with a recorded copy of the Stormwater Management & BMP Facilities Agreement. With the operation and maintenance manual described in item 3 as a recorded exhibit.
Miscellaneous Condition Resolved Prior to Completion
Development & Permitting Services
Pierce County Auditor's recording fee for the Stormwater Agreement must be paid prior to closing the permit. [Robin Loewen @ 09/30/2025 1:47 PM]

Related Permit & Planning Applications

Reference Number Status Type
B-21-0029 Closed Change of Use
E-21-0071 Canceled Civil Construction Permit
B-21-0263 Canceled Commercial - Tenant Improvement/Remodel
PRCTI20250103 Closed Commercial - Tenant Improvement/Remodel
PRFS20250323 Closed Fire Sprinklers
PRFA20251121 Closed Fire Alarms
PRSC20251400 Closed Utility Service Connection
P-20-0050 Expired Pre-Application
P-20-0137 File Closed Temporary Use
PLSSP20220062 File Closed SEPA Standalone
PLLC20250043 File Closed Lot Combination

Documents & Images

Date Uploaded File Type Name
01/20/2025 Report SUPPLEMENTAL INFILTRATION TESTING
01/20/2025 Report INFILTRATION FEASIBILITY
01/20/2025 Form APPLICATION
01/21/2025 Receipt Receipt for transaction:2025-000135
03/31/2025 Letter Permit Review Correction Letter
04/04/2025 Report SEPA Determination
04/25/2025 Report CONSTRUCTION SWPPP - RESUB
04/25/2025 Other ESTIMATE, OFF-SITE - RESUB
04/25/2025 Other ESTIMATE, ON-SITE - RESUB
04/25/2025 Report O & M MANUAL - RESUB
04/25/2025 Form CORRECTION RESPONSE LETTER
04/29/2025 Receipt Receipt for transaction:2025-000823
05/21/2025 Other Engineering Estimate of Cost Break Down 2025.04_APPROVED
05/22/2025 Report STORMWATER REPORT - RESUB (Flattened)
05/22/2025 Report CES_ProVac_InterAve_M_PerviousHMA0 (Flattened)
05/23/2025 Plans CIVIL PLANS - RESUB (Stamped)
06/02/2025 Receipt Receipt for transaction:2025-001040
07/02/2025 Permit Permit - Detailed
09/15/2025 BF CERT 1 OF 2
09/15/2025 BF CERT 2 OF 2
10/01/2025 Receipt Receipt for transaction:2025-001903
10/01/2025 SWA - PRCCP20250096 - RECORDED & CCO STAMPED
